WorkflowSupply Chain, Procurement & Finance

Construction Change Order Review

Construction change order review that asks whether anything is owed before it asks how much

Every claim tested against the contract before it is priced, not after it is paid.

See one case, screen by screen ↓
demo$1,152,383held back on the 9 of 11 open change orders checked so far — not entitled, above contract rates or above the field quantities
demo$898,100found recoverable on 121 of the 214 change orders approved in the last 12 months, by re-checking every one
demo$237,632over the contract on one cable tray claim even before entitlement — $640,012 claimed, $402,380 at contract rates and the 10% markup
target214of 214approved change orders re-checked against the contract each year, not a manual sample of 20
In short

What is Construction Change Order Review?

Software that checks each contractor change order against the contract before it is paid. Construction Change Order Review tests entitlement first — is it a change, who carries the design or the risk, was it instructed, was notice in time — and only then prices the claim at the contract’s own rates and markup, matches the quantities to field records and drafts a cited response. The contract administrator decides and signs.

How to choose AI solutions for utilities →

Updated

The problem

Why change orders get paid that were never owed

A change order arrives as a PDF, a pricing spreadsheet and a covering letter. To answer it properly, the contract administrator needs the Employer’s Requirements (hundreds of pages), the bill of quantities, the schedule of rates, the drawing register, the tender clarifications and the site diaries — each kept somewhere else — and a 42-day response window is already running. So the quickest thing gets done: re-price the quantities and negotiate the number.

That order is backwards. A claim for work that was always in the contract can be negotiated down and still be paid. Markups arrive at 15% plus supervision plus insurance when the contract allows 10% all-in, new pay items go in with no pricing review, and nobody records that notice came after the 28 days, so the defence is lost. Internal audit can sample 20 approved change orders a year by hand, which says nothing about the rest.

typical48%of change orders reviewed by a city auditor general had markups not applied according to contract terms
typical8–14%of original contract value is the industry norm for change orders
typical17of 18pay items added by change order had no documented pricing review in one city’s internal audit
Where a change order’s response days goestimated
By hand27 days
With the solution3.2 days
  • Logging the request and reading the claim, letter and quotes2 → 0.1 d
  • Finding the clauses, the scope, the bill items and the drawing revisions8 → 0.5 d
  • Dating the event, the notice and the particulars2 → 0.1 d
  • Chasing quantities from daily reports, logs and surveys6 → 1 d
  • Pricing at the contract’s own rates and markup5 → 0.5 d
  • Drafting, reviewing and signing the response4 → 1 d

Estimated split for one contested change order, in working days, by hand and with the solution.

How it works

How a change order moves

Seven agents test entitlement first, then price each claim at the contract's own rates; the contract administrator decides.

What comes in
Claims in5 sources · requests, contract, rates, quotes, field records
Agents at work
Claim readerlines · dates
Then
Clause finder
Scope checker
Notice clock
Then
Field record matcher
Rate and markup checker
Then
Response writerevery clause cited
A person decides
Contract administratordecides and signs
What comes out
Entitlement verdict
Markup recalculated
Signed response
One case, step by step

One cable tray claim, from the contractor’s letter to a signed response

Lumina Utilities is building Harbourside, a 132/11 kV substation, under a $48.6M design-build EPC contract with Calder & Voss Electrical. On Oct 2, 2026 the contractor submits change order HBS-CO-047: $640,012 for additional cable trays in the 11 kV switchroom and cable basement. Here is what happens on Oct 13, screen by screen, in the working solution.

  1. 01Morning, Oct 13

    The claim opens with a verdict before a price

    Leah Moreno · Contract administrator

    Leah acts for the Engineer on Harbourside and Eastbank and has 11 change orders open, each on its 42-day response clock. HBS-CO-047 is on day 11 of 42. On the left, the claim as Calder & Voss wrote it; in the centre, the entitlement gate; on the right, the cost check against the contract rates. The overnight check, run 06:38–06:47, has already answered the four tests.

    Not entitled: “In the original scope; the contractor’s own design change; no instruction; notice 18 days late” · Reject · $0 · recommendation · you decide

  2. 0206:38

    The claim, as submitted, and nothing priced yet

    Claim reader

    The claim reader lists what the contractor asked for: 1,860 m of 600 mm heavy-duty ladder tray at $182, 1,240 supports at $64, 1,150 hours of re-routing and pulling labour at $78 and a $17,020 scaffold lump sum — $524,600 direct, then 15% overhead and profit, 5% supervision and 2% insurance and bonding. The reason, quoted from letter CV-L-0441: the trays follow “the revised cable routing on drawing HBS-E-2104 rev D”. Leah can replay the check step by step; the cost column stays locked while the tests run.

    “Valuation waits for entitlement” · “Waiting for entitlement — the cost is checked only after the four tests are answered.”

  3. 03Test 1

    Is it a change to the Works? No — the trays were always in scope

    Scope checker

    The Employer’s Requirements, Part 6, §6.4.2 on p. 214 already require “all cable trays, ladders, supports and fixings for the complete cable installation, including the 11 kV switchroom and the cable basement”, with 25% spare capacity. Bill item E-4.12, “Cable containment, complete — lump sum”, was priced at $1,118,400 in the tender, and tender clarification TQ-22 confirmed the spare capacity is in the lump sum. Anyone can run the same search on the Scope screen.

    “Work the contract already describes is in the contract price unless an instruction changed it.”

  4. 04Tests 2 and 3

    The contractor’s own design, and no instruction to vary

    Scope checker and Clause finder

    Drawing HBS-E-2104 rev D was issued by Calder & Voss’s own design team on transmittal CV-T-0318, Aug 4, and Lumina’s requirements have not changed since award. Under Sub-Clause 4.1 the contractor is “responsible for the adequacy of the design and for its development”. The only instruction is site instruction SI-112 of Aug 12: “Rev D routing approved for construction — no change to the Contract Price”. Sub-Clause 13.1 is quoted beside it, word for word, with its page.

    Scope checker: “Reports what the documents say; never decides entitlement.”

  5. 05Test 4

    Notice on day 46 of a 28-day limit

    Notice clock

    Calder & Voss became aware on Aug 4, the date of the rev D transmittal. Their notice letter CV-L-0441 is dated Sep 19 — 46 days later, against the 28 days of Sub-Clause 20.2.1, which fell on Sep 1. The notice ruler draws both. Beneath it, the run log shows every agent step with its time.

    “A late notice is a further ground; the contractor may ask for it to be excused — that decision is yours.”

  6. 06For the record

    Then the cost check — 37% over, before entitlement

    Rate and markup checker · Field record matcher

    The cost column opens, marked for the record. The tray is claimed at $182 against $131 in Schedule of Rates E-4.12.3 (+39%), supports at $64 against $41, labour at $78 against $62 on dayworks DW-3, and the scaffold is already in preliminaries item P-14. The claimed 22% markup becomes the contract’s 10% all-in under Appendix C. At contract rates the claimed quantities are worth $402,380; at the field quantities — the tray installation log shows a net change of 140 m, not 1,860 m — they are worth $102,934. The subcontractor quote attached by Calder & Voss prices the tray at $118/m.

    Rate and markup checker: “Never values a claim before entitlement is answered.”

  7. 07Signed

    Leah rejects at $0 and signs the response

    Leah Moreno · Contract administrator

    The response writer has drafted the letter to Owen Pryce, Commercial Manager at Calder & Voss, test by test, quoting §6.4.2, Sub-Clauses 4.1, 13.1 and 20.2.1. The value at contract rates is attached for the record only, stating it does not admit any entitlement. Leah can edit anything, picks the meaning of her signature and signs and sends.

    “Drafted by the Response writer · every clause quoted · edit anything before you sign”

  8. 08Next

    An entitled claim — priced at the contract, not the claim

    Leah Moreno · Contract administrator

    HBS-CO-051, rock excavation in transformer bay T2, passes all four tests: borehole BH-07 showed stiff clay to 4.5 m, so the rock is unforeseeable ground under Sub-Clause 4.12, and notice came on day 6. Now the valuation unlocks: rock at the contract’s $112/m³ instead of $148, and 1,480 m³ on the as-dug survey. The recommendation is to negotiate at $210,012 of the $294,030 claimed.

    “Entitled, but priced above the contract. Offer the contract value.”

  9. 09The queue

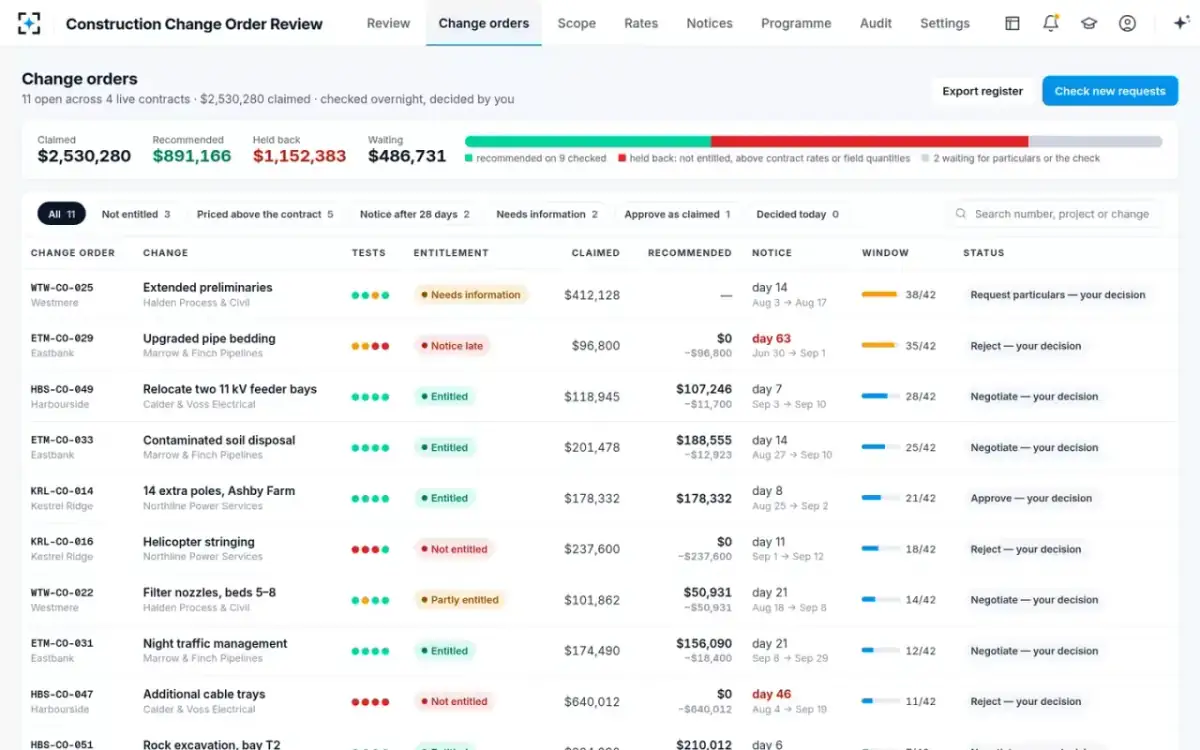

    Eleven change orders, each with its verdict and its clock

    Arjun Mehta · Project controls analyst

    The register shows the whole queue across four live contracts: $2,530,280 claimed, $891,166 recommended on the 9 checked, $1,152,383 held back and $486,731 waiting for particulars or the check. Filters pick out the claims not entitled, priced above the contract or notified after 28 days. WTW-CO-025, extended preliminaries at Westmere, is on day 38 of 42 and needs a request for particulars.

    “11 open across 4 live contracts · $2,530,280 claimed · checked overnight, decided by you”

  10. 10Every month

    Every approved change order re-checked, not a sample

    Grace Lindqvist · Internal audit manager

    The audit re-check runs all 214 change orders approved from Oct 2025 to Sep 2026 back through the same tests. It finds markups not applied as the contract says on 61, extra charges on top of the markup on 38, work already in the contract paid again on 9 and quantities above the field records on 17 — $898,100 recoverable from 121 of them. 14 late notices were paid with no recorded decision. Recovery letters are drafted for 4 contractors and not sent.

    “214 re-checked this year · 20 a manual sample would cover”

Who it’s for

Built for everyone who stands behind a change order decision.

The same claim, seen by the four people who decide it, price it, co-sign it and audit it — what their month looked like, and what it looks like now.

LM
Leah MorenoContract administrator, Capital Delivery · acts for the Engineer on Harbourside and Eastbank · decides and signs
Contract administrator
Before
Has 11 open change orders, each on a 42-day response clock, and the contract documents in five places. “I can argue a rate all week. The question is whether we owe anything at all.”
Now
Opens each claim with the four entitlement tests answered, every clause quoted with its page, and a drafted response she edits, signs and sends.
AM
Arjun MehtaProject controls analyst · prices change orders, checks quantities
Project controls analyst
Before
Prices change orders, keeps the cost report and chases quantities from site. “I re-price the claim, then find out the work was in the bill all along.”
Now
Sees every claimed rate against the contract rate, every markup recalculated as the contract says, and the field record behind each quantity.
SH
Samir HaddadHead of Capital Delivery · co-signs any change order over $250K
Head of Capital Delivery
Before
Answers to the CFO for the programme. “Eastbank is at 15% of contract. I need to know which of those we never owed.”
Now
Sees change orders as a share of each contract against the 8–14% norm, and why money was held back, by the test that held it.
GL
Grace LindqvistInternal audit manager · reads every check, runs the re-check
Internal audit manager
Before
Samples 20 approved change orders a year by hand. “A sample of 20 out of 214 tells me nothing about the other 194.”
Now
Gets all 214 re-checked against the same tests, findings by type with dollars, and recovery letters drafted for review.
Built on the engine

7 agents. Each with one job, and hard limits.

Seven agents test entitlement first, then price each claim at the contract's own rates; the contract administrator decides.

Claim reader

Reads each change order request, its covering letter and quotes, and lists the claimed lines, quantities, rates, markups, the event and notice dates and the contractor’s stated reason, quoted word for word.

  • Never edits a submission
  • Every number points to its page
Clause finder

Finds the contract clauses that apply — variation, notice, design responsibility, risk, provisional sums — in the Conditions of Contract, appendices and tender clarifications, and quotes them word for word with their page.

  • Never paraphrases a clause without the quote beside it
Scope checker

Compares the claimed work with the Employer’s Requirements, the bill of quantities, the preliminaries, the drawing revisions and who issued them, and reports whether the work is already included.

  • Reports what the documents say; never decides entitlement
Notice clock

Dates the event, the notice and the particulars, and measures them against the 28-day and 84-day limits and the 42-day response window.

  • Never declares a claim time-barred — flags it late for the contract administrator
Field record matcher

Matches claimed quantities to daily reports, installation logs, as-dug surveys, weighbridge tickets and photos, and reports the field quantity and the gap.

  • Never accepts a quantity with no field record behind it
Rate and markup checker

Prices the quantities at the contract’s own rates, recalculates the markup as the contract says and flags extra charges, such as supervision or insurance, that the markup already covers.

  • Never values a claim before entitlement is answered — if entitlement fails, it values for the record only
  • Flags a rate more than 5% above the contract rate
Response writer

Drafts the response or determination to the contractor — rejection, counter-offer, approval or request for particulars — citing every clause and record.

  • Never sends; only the contract administrator signs
Contract administrator

Decides and signs; co-sign over $250K. The agents propose; a named person decides.

Ask in plain words

Ask about any change order, in plain words

Ask about any change order, clause, rate or notice — or say what to draft. Every answer points to its clause or record.

Why is the cable tray claim not a change?

Because the trays were always in the contract. Employer’s Requirements §6.4.2 requires “all cable trays, ladders, supports and fixings… including the 11 kV switchroom and the cable basement”, and bill item E-4.12 prices it at $1,118,400. Rev D was Calder & Voss’s own drawing, SI-112 said “no change to the Contract Price”, and notice came on day 46 of 28.

Which claims came after the 28-day notice limit?

Two: ETM-CO-029, upgraded pipe bedding — notice on day 63; it is the only ground left, so it needs your view and a legal opinion. And HBS-CO-047, cable trays — day 46, though it already fails on scope. Every other notice in your queue landed inside 28 days.

Where are markups above the contract’s 10%?

On four claims in your queue, $100,390 above the contract’s markup at the claimed quantities: HBS-CO-047 cable trays at 22% against 10% all-in ($62,952, for the record); ETM-CO-031 night traffic management, an $18,400 supervision lump sum on top of 10%; HBS-CO-049 feeder bays at 22% ($11,700); and HBS-CO-052 fire suppression at 22% ($7,338, check still running).

Draft the request for particulars on WTW-CO-025

Drafted. It asks Halden Process & Civil for the delay analysis on the accepted programme, the time-related costs behind the $41,200 a week for site staff, and the fully detailed claim due by Oct 26 under Sub-Clause 20.2.4. It goes out before day 42 (Oct 17). The draft is open for you to sign.

Every screen

The working solution, as it ships.

13 screens from the working solution, on its sample data. Pick one to see it large.

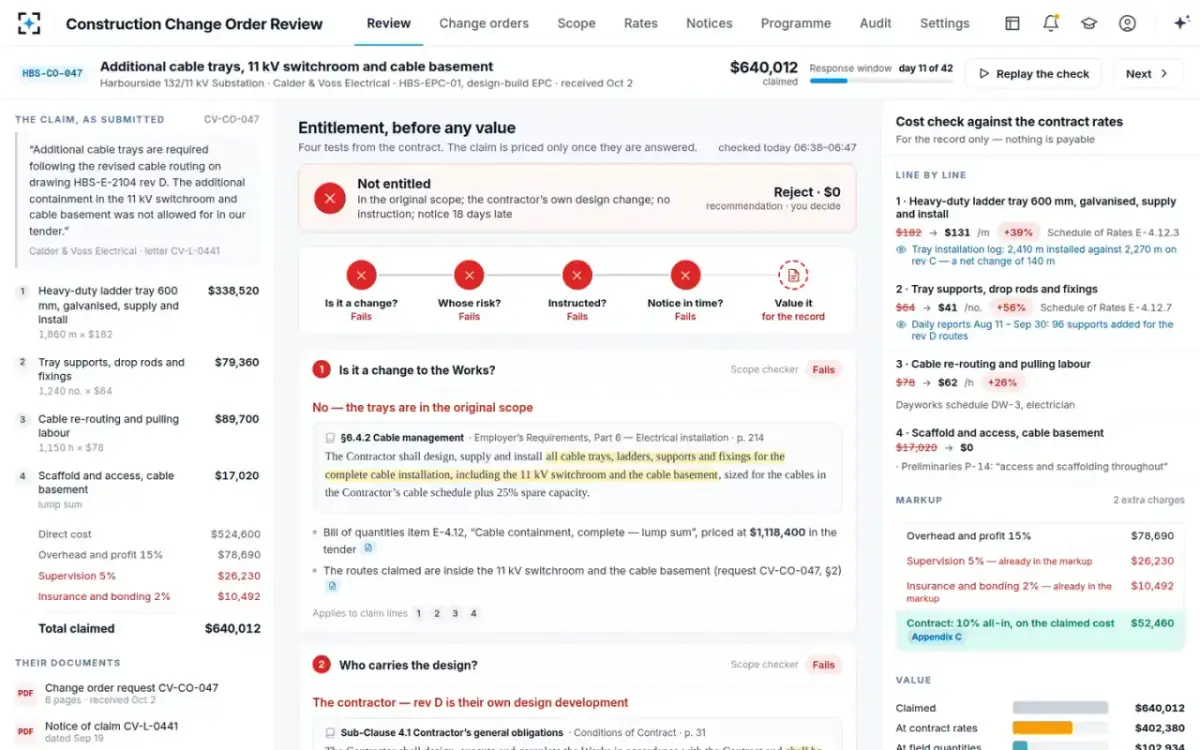

The entitlement gateThe claim as submitted, four entitlement tests with their clauses quoted, and the cost check against the contract rates.

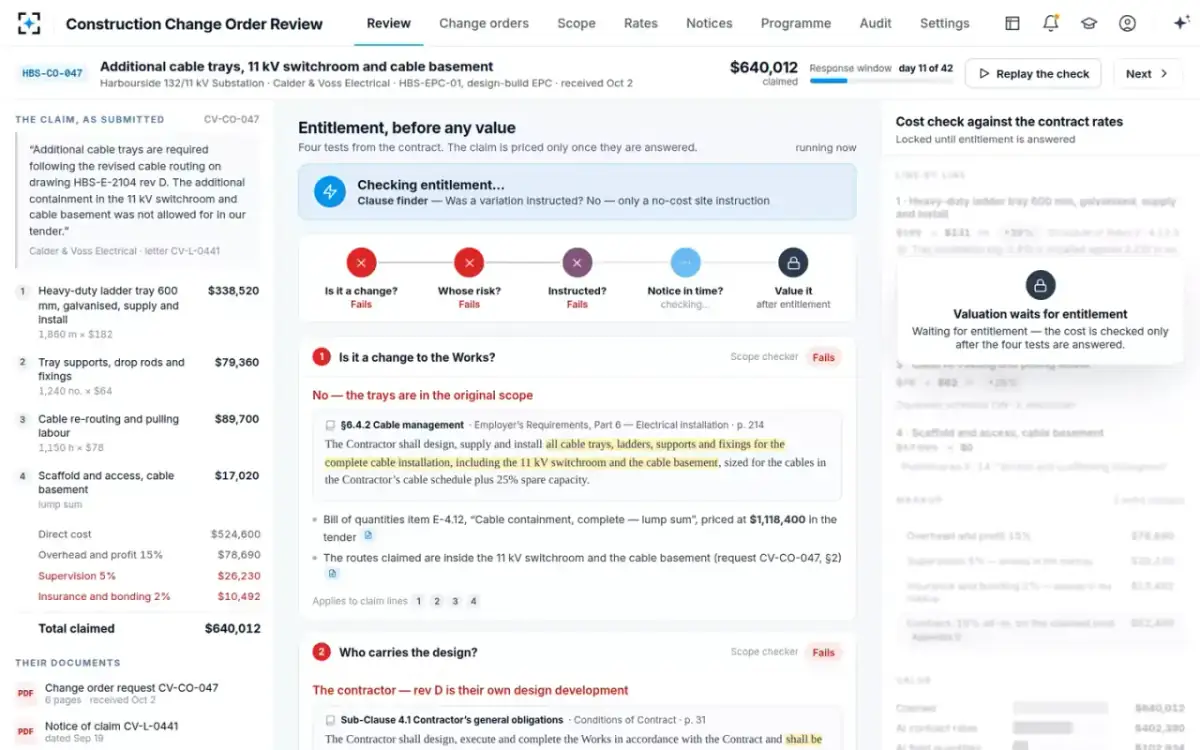

The check, replayedThe tests answered one by one while the valuation stays locked until entitlement is answered.

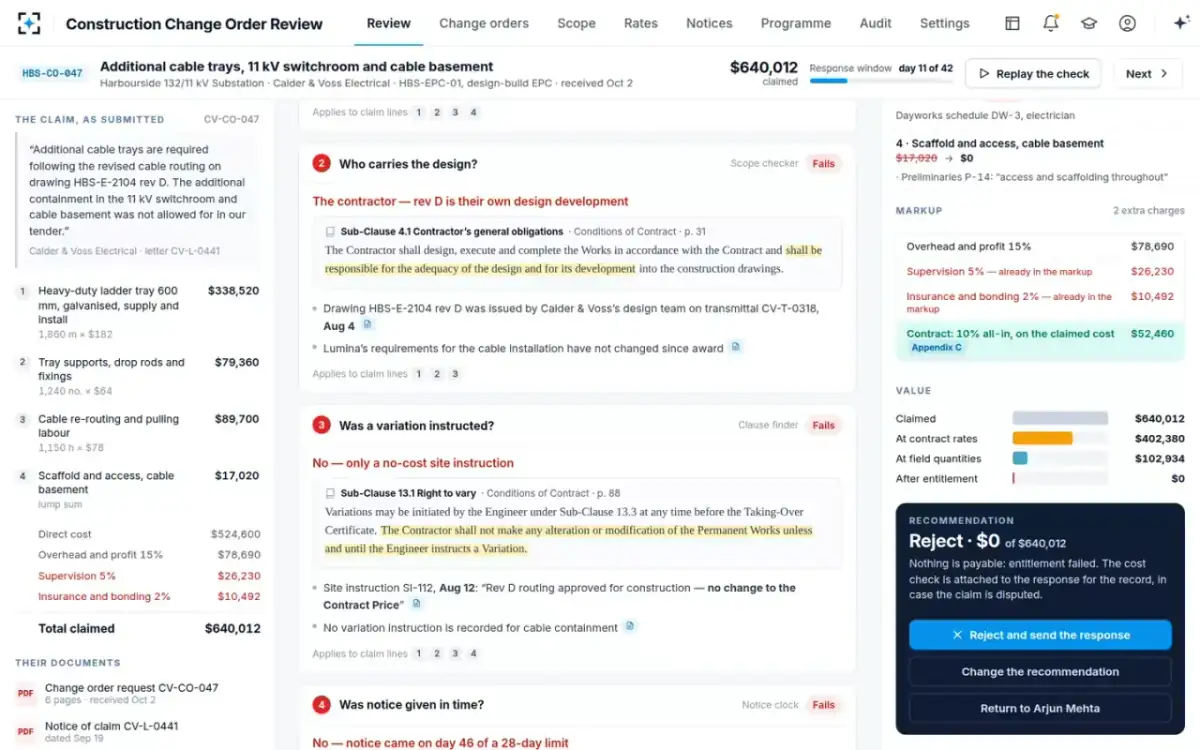

Design and instructionWho carries the design and whether a variation was instructed, each clause quoted with its page, beside the recommendation.

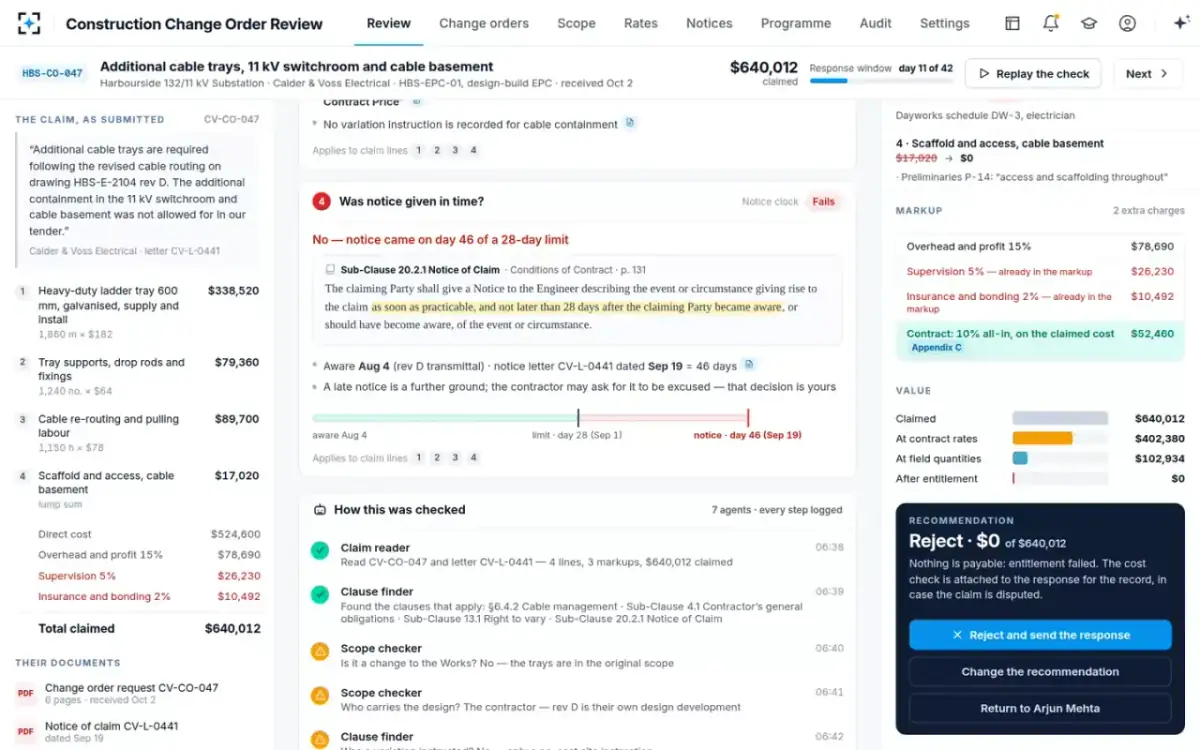

The notice rulerThe 28-day notice limit against the day the notice landed, and the run log of every agent step.

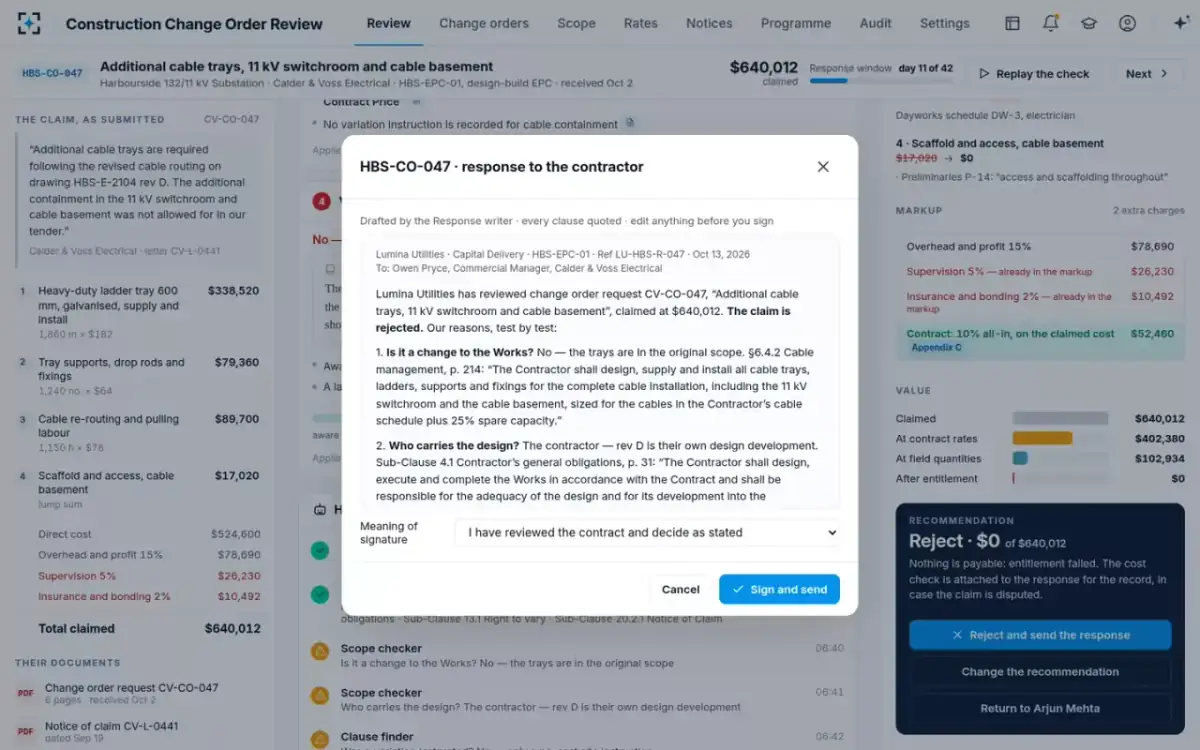

Sign and sendThe drafted response with every clause quoted, the meaning of the signature, and sign and send.

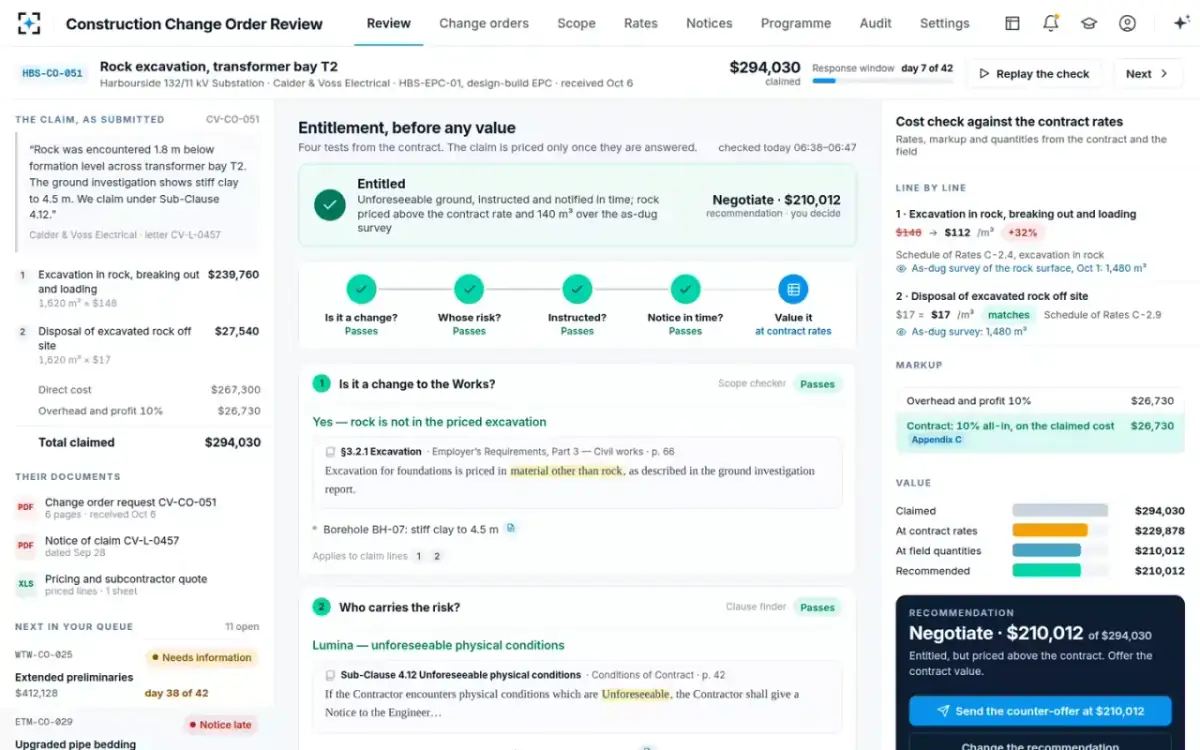

An entitled claimFour tests passed, the valuation unlocked, and the claim priced at the contract rate and the surveyed quantity.
The change order registerEvery open change order with its tests, entitlement, claimed and recommended values, notice days and response window.

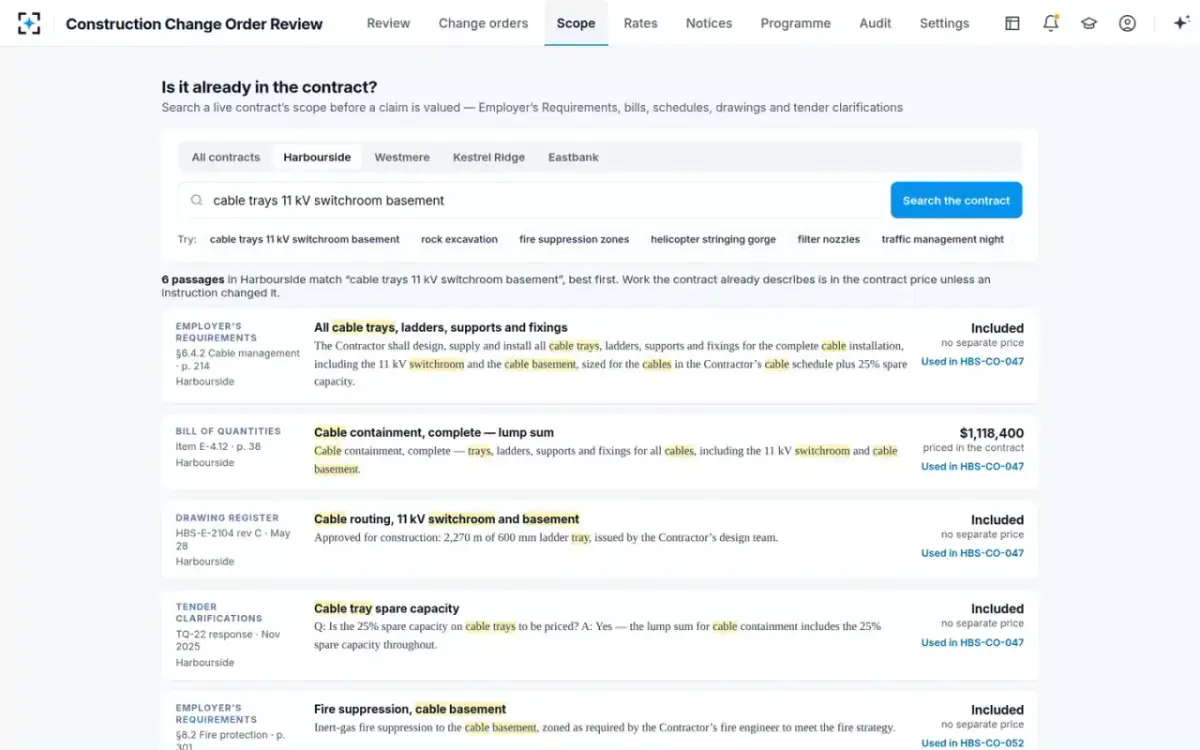

Is it already in the contract?A search across the Employer’s Requirements, bills, schedules, drawings and tender clarifications of a live contract.

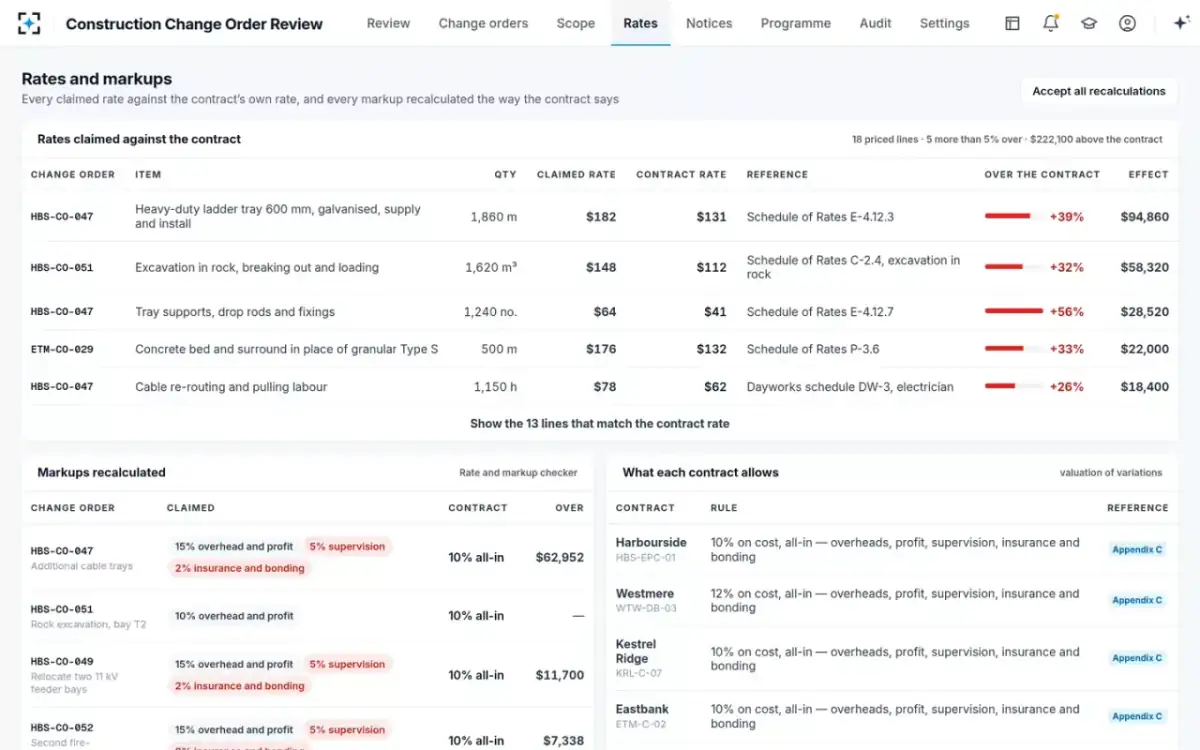

Rates and markupsEvery claimed rate against the contract rate, every markup recalculated, and what each contract allows.

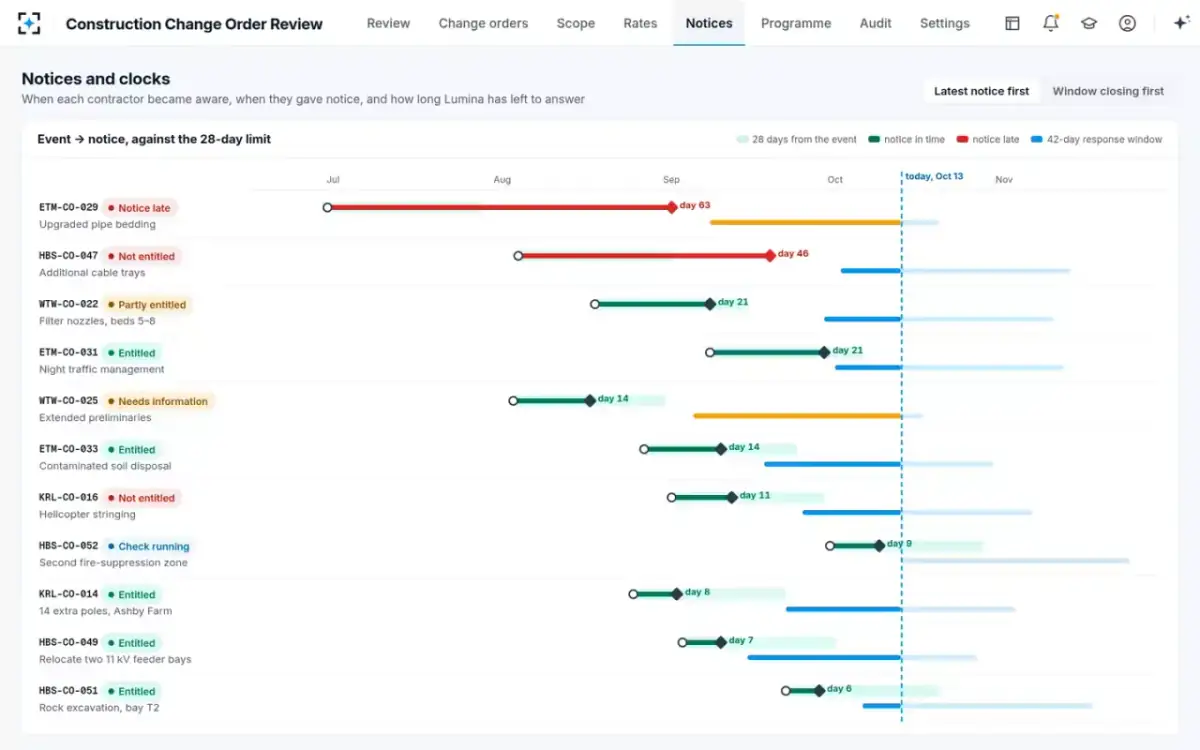

Notices and clocksEach event and notice against the 28-day limit, and the 42-day response windows up to today.

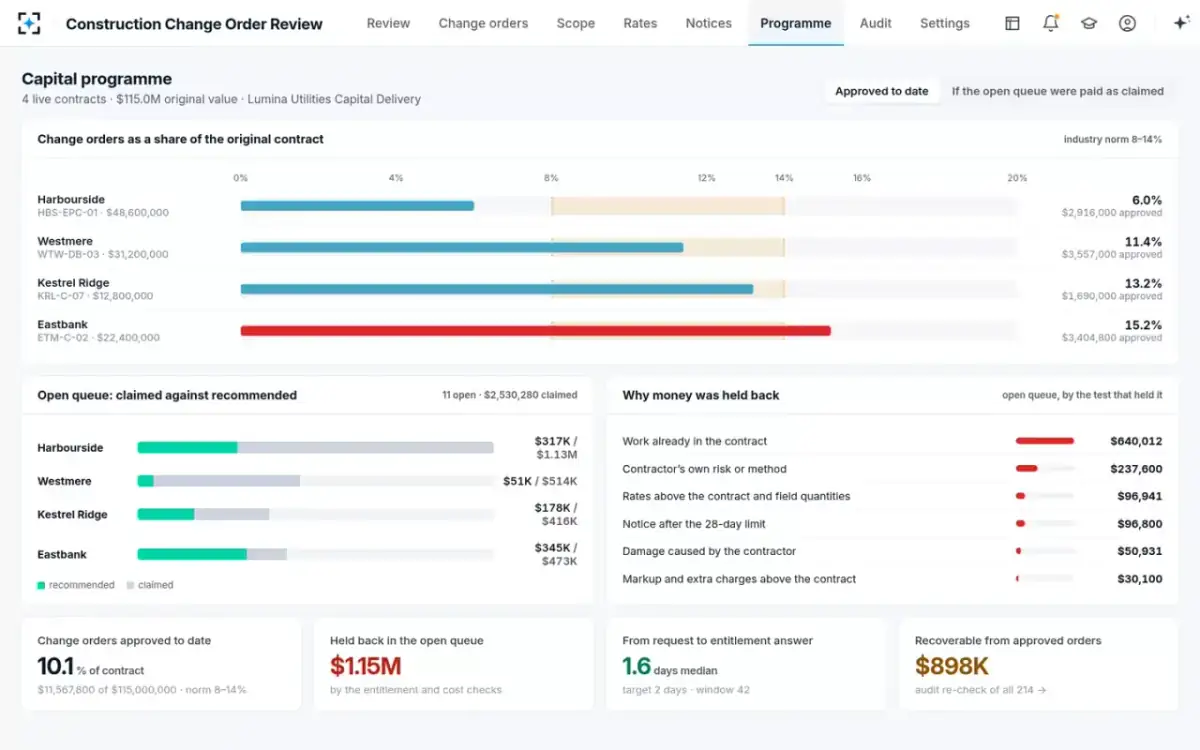

The capital programmeChange orders as a share of each contract against the 8–14% norm, and why money was held back.

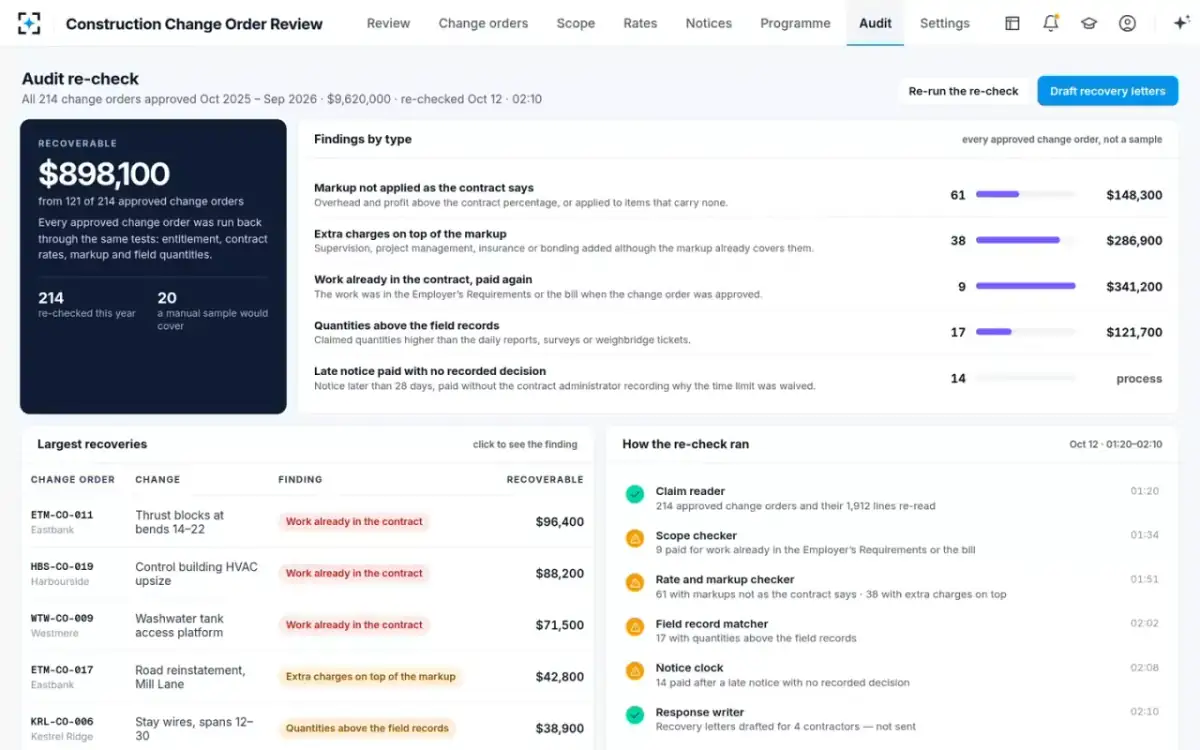

The audit re-checkAll 214 approved change orders re-checked, findings by type with dollars, and the largest recoveries.

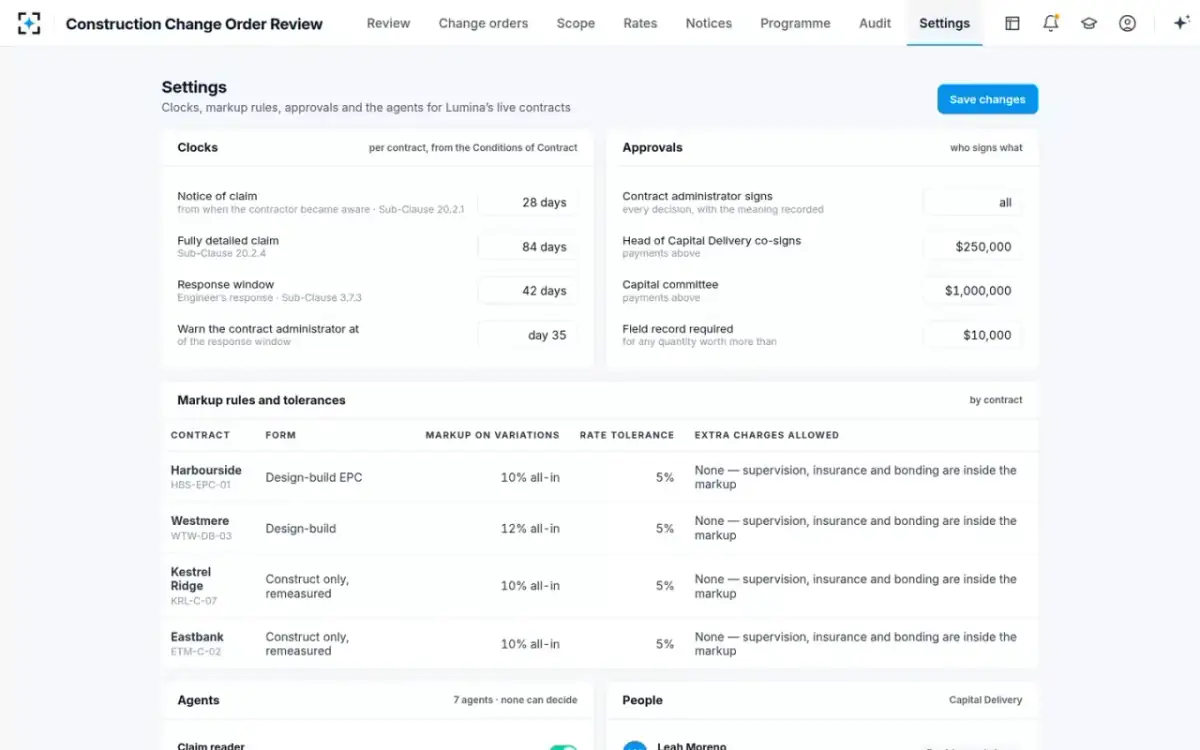

Your rulesClocks, approvals, markup rules and rate tolerances per contract, and the agents and people.
Governance

Built to be defended: quoted, signed, on the record.

Every verdict quotes its clauseEach entitlement test shows the clause word for word with its document and page, and the evidence behind it — the drawing transmittal, the site instruction, the letter dates. Every quantity shows its field record.
Entitlement before value, enforcedThe valuation step stays locked until the four tests — is it a change, whose risk, was it instructed, was notice in time — are answered. When entitlement fails, the cost check is marked for the record only.
The contract administrator decides and signsAgents read and draft; only the contract administrator rejects, negotiates, approves or requests particulars, with an electronic signature and its meaning recorded. The Head of Capital Delivery co-signs above $250,000 and the capital committee above $1,000,000.
A time-bar no agent appliesThe notice clock flags a late notice and shows the 28-day limit against the day it landed; it never declares a claim time-barred. That decision, and its reason, stays with the contract administrator.
Every check on the recordEvery agent step, edit, signature and letter is logged with its time, and the check can be replayed step by step. Approved change orders are re-checked against the same tests, so internal audit reads the whole population.
Contract documents stay with the utilityThe contract, its schedules and the site records stay in the utility’s own environment. Contractors see only the response sent to them, and recovery letters stay drafts until someone signs.
Configuration

Your contracts’ rules, not ours

The clocks, the markup rules, the tolerances and who signs what are settings, taken from each contract’s own conditions.

SettingDefaultChoose from
Notice of claim28 daysFrom when the contractor became aware · Sub-Clause 20.2.1 — set per contract from its Conditions of Contract
Fully detailed claim · response window84 days · 42 daysSub-Clause 20.2.4 and the Engineer’s response under Sub-Clause 3.7.3 — set per contract
Warn the contract administrator atDay 35Set as a day of the 42-day response window
Markup on variations10% all-inPer contract — 12% all-in on Westmere; supervision, insurance and bonding are inside the markup
Rate tolerance5%Per contract — a rate further above the contract rate is flagged
Co-signatureAbove $250,000Head of Capital Delivery co-signs; the capital committee above $1,000,000
Field record requiredAbove $10,000Any quantity worth more than this needs a field record behind it
Meaning of signatureI have reviewed the contract and decide as statedI have reviewed the contract and decide as stated · I decide as stated, subject to legal review
Connections

Works with the documents a change order is already argued from

Change order requeststhe contractor’s request, notice letters and pricing spreadsheets
Conditions of Contractvariation, notice, design and risk clauses, appendices and tender clarifications
Bills and schedules of ratesbill of quantities, schedule of rates, dayworks and preliminaries
Employer’s Requirements and drawingsscope sections and the drawing register, with who issued each revision
Field recordsdaily reports, installation logs, as-dug surveys, weighbridge tickets and photos
Subcontractor quotesthe quotes attached to a claim, read against the rate claimed
What it changes

The difference, in numbers.

Every figure is labelled: a target the solution is built to, an estimate, a typical published result, or a proven one.

estimated
$1.3Ma year
of change-order cost not paid on a $420M capital programme
$1.34M of $33.6M
4% of change-order spend held back
target
214of 214
approved change orders re-checked against the contract, not a sample of 20
Manual sample20 a year
With agentsall 214
target
2days
to an entitlement answer, inside the 42-day response window
Day 2 of 42
median target

“demo” = seen in the working solution, on its sample capital programme · “target” = the design goal, measured in the live solution · “estimated” = our estimate (the working-days split; the results’ $1.3M = $420M programme × 8% change orders × 4% held back) · “typical” = published figures: City of Toronto Auditor General, change orders in capital projects (2026) — markups not per contract on 48%; South Florida Water Management District Inspector General (2024) — industry change-order norm 8–14% of contract value; City of Fort Worth Internal Audit (2022) — 17 of 18 added pay items with no documented pricing review. Contract clocks named as context: FIDIC 2017 Sub-Clauses 20.2.1 (28 days), 20.2.4 (84 days) and 3.7.3 (42 days). Lumina Utilities and the people, contractors, projects and records named on this page are fictional — characters and sample data in the working solution.

Questions

What capital delivery and project controls teams ask us.

What is construction change order review software?

Software that checks each contractor change order against the contract before it is paid. Construction Change Order Review tests entitlement first — is it a change, who carries the design or the risk, was it instructed, was notice in time — and only then prices the claim at the contract’s own rates and markup, matches the quantities to field records and drafts a cited response. The contract administrator decides and signs.

How does change order review work, step by step?

The claim reader lists the claimed lines, markups and dates. The clause finder, scope checker and notice clock answer the four entitlement tests, each with its clause quoted word for word. Then the field record matcher and the rate and markup checker price the claim at contract rates and field quantities, and the response writer drafts the letter.

Does it catch markups and extra charges above the contract?

Yes. It recalculates every markup the way the contract says and flags extra charges the markup already covers. In the sample queue, a claimed 15% overhead and profit plus 5% supervision plus 2% insurance and bonding is recalculated to the contract’s 10% all-in, and four claims carry $100,390 above the contract’s markup at the claimed quantities.

Can internal audit check every approved change order, not a sample?

Yes. The audit re-check runs every approved change order back through the same tests — entitlement, contract rates, markup and field quantities. On the sample data it re-checked 214 approved change orders and found $898,100 recoverable from 121 of them, with recovery letters drafted and not sent.

Does it decide that a late claim is time-barred?

No. The notice clock measures the notice against the 28-day limit and flags it late; it never declares a claim time-barred. The contract administrator decides, and can sign with the meaning “I decide as stated, subject to legal review”.

Does it work with our contract forms?

The clocks, markup rules and rate tolerances are set per contract from its own conditions. The sample programme mixes design-build EPC, design-build and construct-only remeasured contracts, with a 10% all-in markup on three and 12% on Westmere.

Do people stay in control of change order decisions?

Yes. Agents read and draft; none can decide. Only the contract administrator rejects, negotiates, approves or requests particulars, with an electronic signature and its meaning recorded, and the Head of Capital Delivery co-signs above $250,000.

How long does it take to go live?

The Agentic Solution Engine builds and deploys it from your requirements and documents — your contracts, schedules of rates, change order procedure and a sample of past change orders — and it goes live once every quality gate has passed. We will walk you through it on your own change orders first.

See it on
your change orders.

We'll run Construction Change Order Review on a sample of your own approved change orders and the contracts behind them.
