WorkflowPower Generation & Desalination

Power Plant Outage Planning

Power plant outage planning that scopes every job from condition data and shows what each finding does to the return-to-service date

Outages scoped right, so they finish on time.

See one case, screen by screen ↓
demo$824,000of outage days avoided on one late boiler finding — the job moved to a parallel night crew for $48,600, and the return date held at Mon 30 Nov
demo3.0daystaken out of the outage by challenging work with no evidence — the clean LP turbines stay closed, 31.0 → 28.0 days
target92%scope stability or better — little work added after the freeze, because findings are scoped from condition data before it
demo26of 26items with no reading, test or bulletin behind them challenged; 9 deferred with their reason, 1,940 crew-hours and $462,000
In short

What is Power Plant Outage Planning?

Software that builds and controls the scope and schedule of a planned unit outage — what work goes in, why, when it is done and what it does to the return-to-service date. Power Plant Outage Planning adds seven agents that build the scope from condition data, challenge work with no evidence and place each job on the critical path; the planner chooses and the outage manager signs.

How to choose AI solutions for utilities →

Updated

The problem

Why a planned outage overruns before breaker open

An outage scope is built from many places at once: open and deferred work orders in the maintenance system, inspection and wall-thickness surveys in PDFs, vibration and performance trends in the historian, OEM bulletins, the plan template from the last outage, and contractors' proposals. The critical-path schedule lives in another tool, and the two are joined by people in spreadsheets and meetings. When a survey finds tubes under minimum wall three weeks before breaker open, the planner learns what it does to the return date only after re-running the schedule by hand.

So scope found late becomes the overrun, and every outage day is replacement energy bought in — and, at a steam unit that also feeds a desalination plant, water made the expensive way. Time-based items carried over from the template take crew-hours, crane time and critical-path days that the condition data says are not needed. Two contractors book the same crane on the same shift. And the lesson from the last outage that would have saved a day is in a register nobody opened.

typical$450,000–700,000a dayof replacement power for one coal unit outage, in a utility's regulatory filing
typical92%scope stability after the freeze is the top-quartile benchmark for outage work management (INPO, cited in an Ontario Energy Board filing)
Where a late finding's working days go, from the survey to a signed scope changeestimated
By hand10 days
With the solution1.8 days
  • Reading the survey and checking each reading against minimum wall1.5 → 0.1 d
  • Drafting the job — steps, materials, crew-hours, permits2 → 0.3 d
  • Re-running the schedule to see the effect on return to service1.5 → 0.1 d
  • Finding and pricing a parallel way to do the job2 → 0.5 d
  • Checking materials, crane and contractor clashes1.5 → 0.3 d
  • Writing up the scope change and getting it signed1.5 → 0.5 d

Estimated split for one late condition finding on a major overhaul, in working days, by hand and with the solution.

How it works

How a finding reaches the outage

Seven agents read the evidence, build the scope and place every job on the critical path; the planner chooses and the outage manager signs.

What comes in
Evidence inreports, work orders, bulletins · inspections, tests, historian, lessons
Agents at work
Condition evidence readerreadings + sources
Evidence challengerno evidence?
Then
Scope builderjob + materials
Readiness trackerstock, ETAs, crane
Then
Critical path schedulerdays + dollars
Then
Sequence advisorparallel ways
Lessons matcherpast outages
A person decides
Outage plannerchooses; outage manager signs the change
What comes out
Evidenced scope
Critical path held
Signed change
One case, step by step

One late boiler finding, from the survey to a signed scope change

Lumina Utilities' Harrowgate Bay Unit B4 is a 320 MW steam unit that also supplies steam to desalination unit D4. Outage B4-26, a major overhaul, opens the breaker on Mon 2 Nov 2026 at 06:00 and returns the unit on Mon 30 Nov: 28.0 days. Today is T-20, and the scope freezes in 3 days. Here is what happens next, screen by screen, in the working solution.

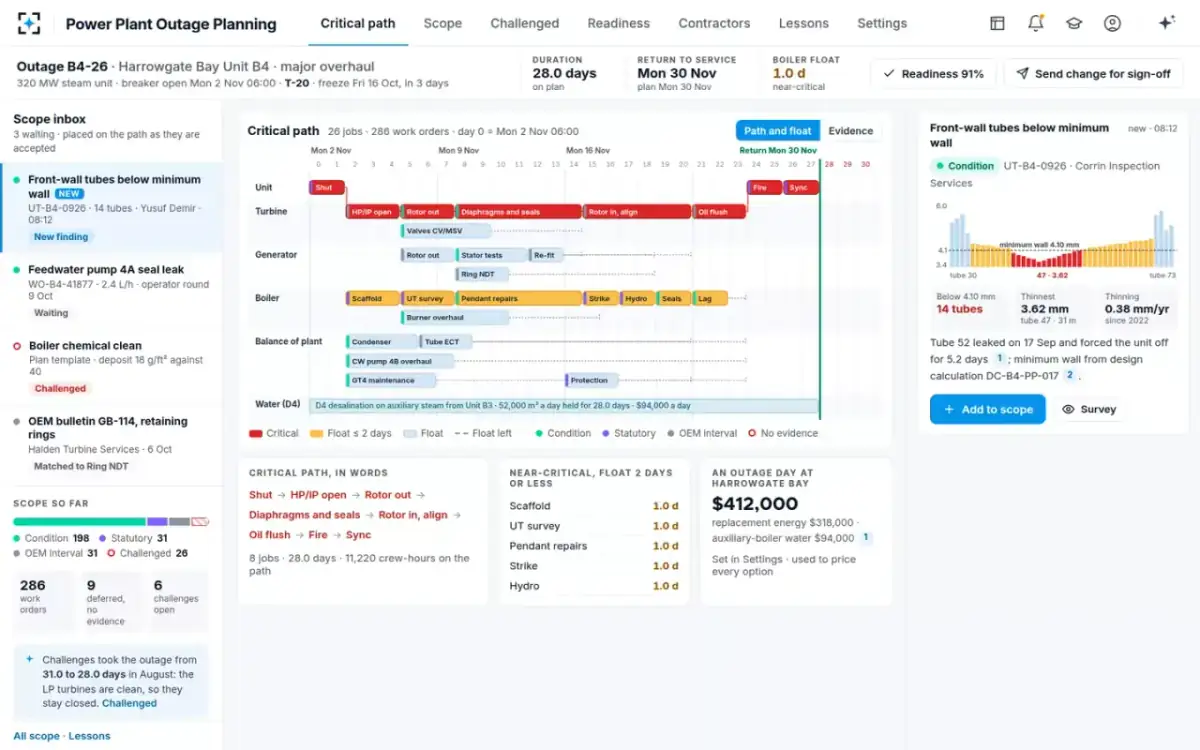

  1. 01T-20 · morning

    The critical path is the home screen

    Mariam Saleh · Outage planner

    Mariam owns the scope and the network for B4-26. Her home is the time-scaled network: 26 jobs and 286 work orders across days 0–30, lanes for unit, turbine, generator, boiler, balance of plant and water, the critical path in red. The header reads 28.0 days on plan, return Mon 30 Nov, boiler float 1.0 day — near-critical. The scope inbox shows three items waiting: the new boiler survey at the top, a feedwater pump seal leak and a challenged chemical clean.

    “An outage day at Harrowgate Bay: $412,000 — replacement energy $318,000 · auxiliary-boiler water $94,000”

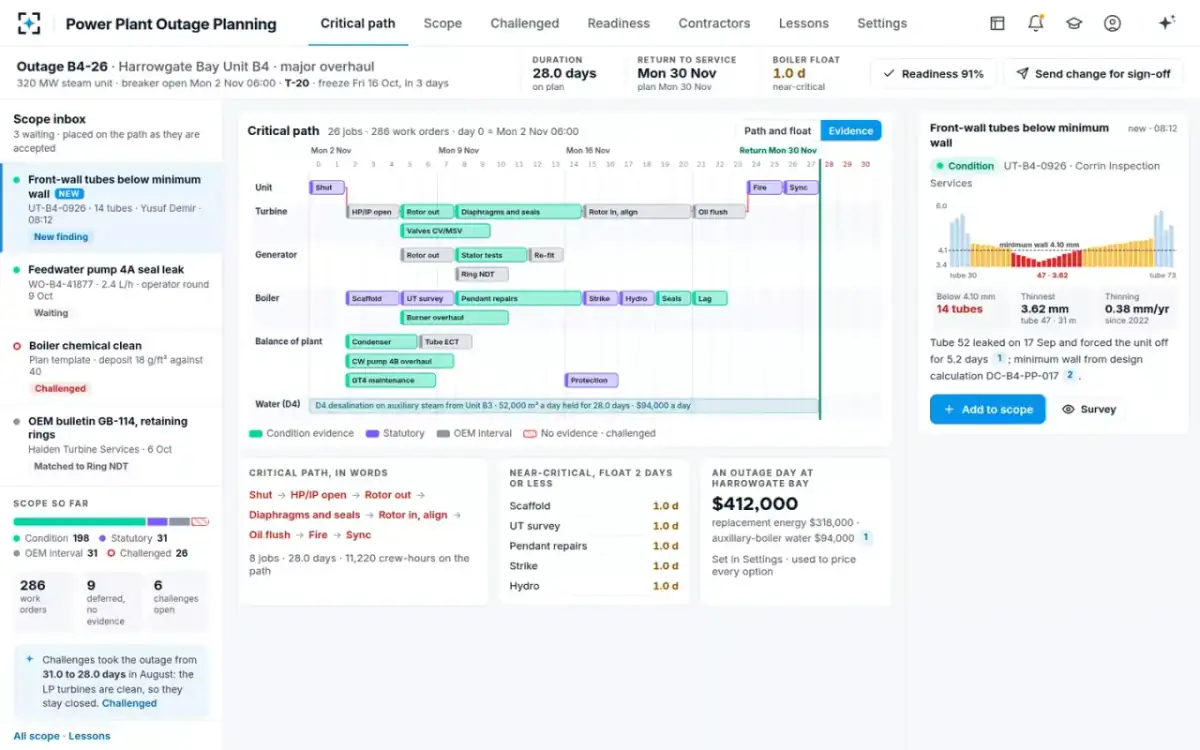

  2. 02One click

    Every bar shows the evidence that put it there

    Condition evidence reader

    Switched to Evidence, the same network is coloured by why each job is in the outage: condition evidence, statutory, OEM interval, or no evidence and challenged. Of 286 work orders, 198 are justified by a condition reading, 31 are statutory, 31 are past the OEM interval and 26 were challenged.

    “Challenges took the outage from 31.0 to 28.0 days in August: the LP turbines are clean, so they stay closed.”

  3. 03Before the freeze

    No reading, no outage time

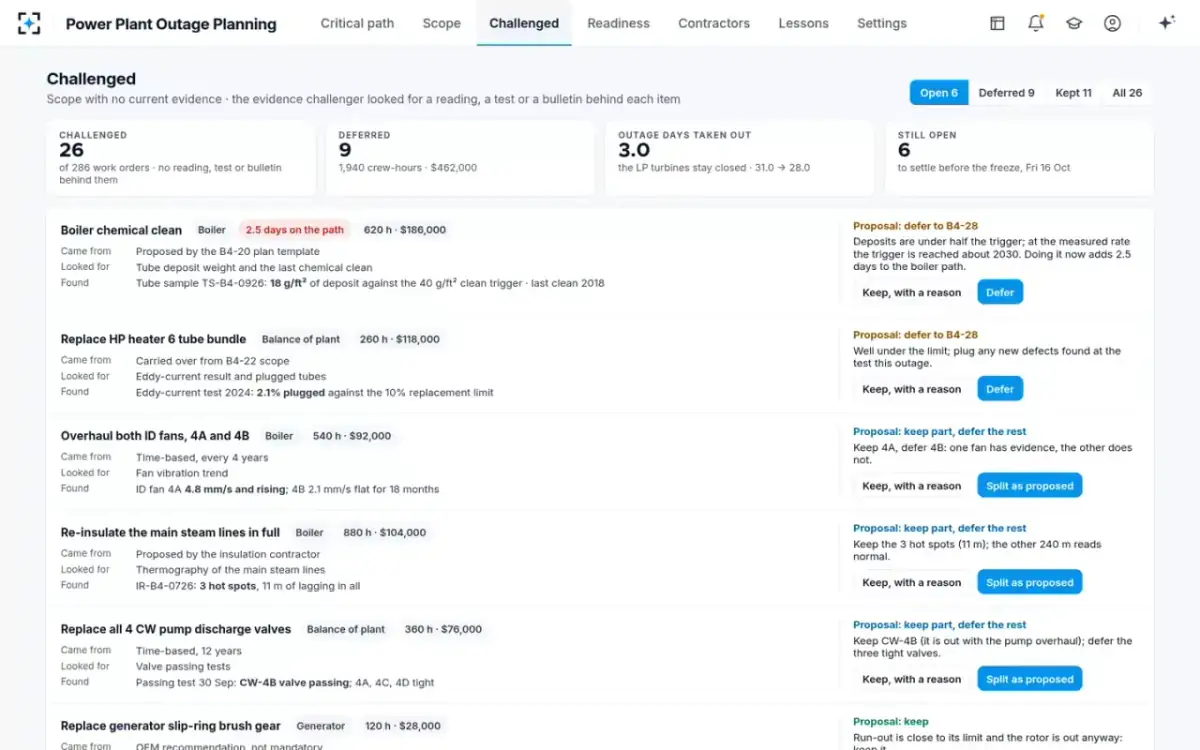

    Evidence challenger

    Each challenged item says where it came from, what the challenger looked for and what it found. The boiler chemical clean came from the B4-20 plan template; tube sample TS-B4-0926 shows 18 g/ft² of deposit against the 40 g/ft² trigger, so the proposal is to defer it to B4-28 and keep 2.5 days off the boiler path. For the ID fans it proposes a split: keep 4A, rising at 4.8 mm/s, defer 4B, flat at 2.1 mm/s for 18 months.

    Statutory items are never challenged · the evidence challenger proposes, the planner decides, the outage manager signs after the freeze.

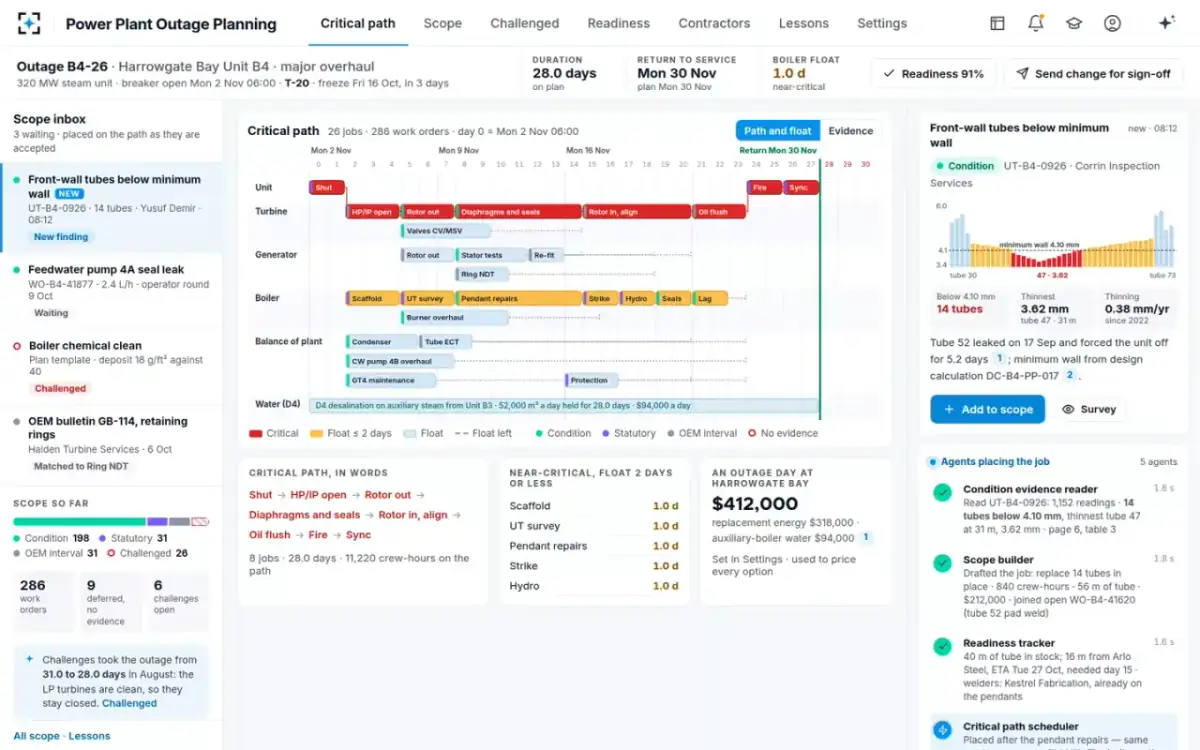

  4. 04Add to scope

    Fourteen front-wall tubes under minimum wall

    Condition evidence reader and Scope builder

    Survey UT-B4-0926 by Corrin Inspection Services, raised by boiler engineer Yusuf Demir at 08:12, found 14 front-wall tubes below the 4.10 mm minimum wall at burner level; the thinnest, tube 47 at 31 m, reads 3.62 mm, thinning 0.38 mm a year since 2022. Tube 52 already leaked on 17 Sep and forced the unit off for 5.2 days. Mariam adds it. The reader goes through all 1,152 readings and cites page 6, table 3; the scope builder drafts the job — 840 crew-hours, 56 m of tube, $212,000 — and joins the open pad-weld work order WO-B4-41620.

    Readiness tracker: “40 m of tube in stock; 16 m from Arlo Steel, ETA Tue 27 Oct, needed day 15.”

  5. 05Seconds later

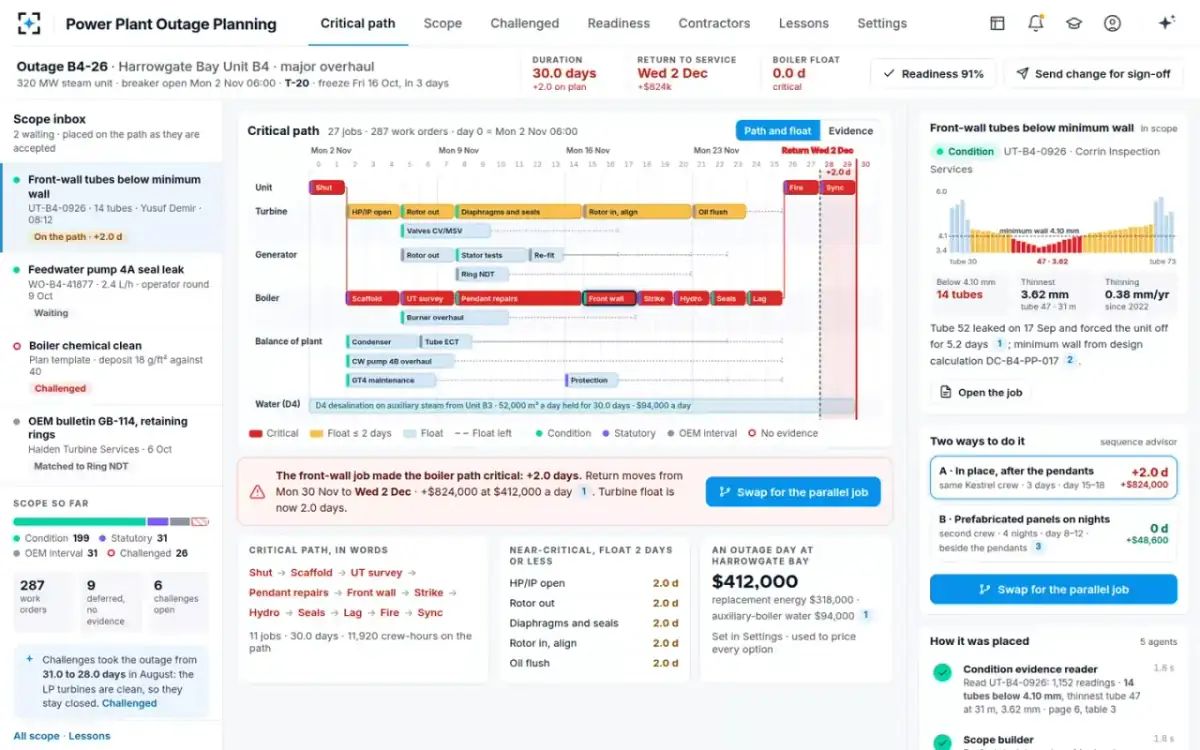

    The boiler path goes critical: +2.0 days

    Critical path scheduler

    Placed after the superheater pendant repairs — same welders, same scaffold lift — the job puts the boiler on the critical path. The network redraws: 30.0 days, return Wed 2 Dec, boiler float 0.0 days. Priced at the value of an outage day, that is $824,000, and the turbine path now has 2.0 days of float.

    “The front-wall job made the boiler path critical: +2.0 days. Return moves from Mon 30 Nov to Wed 2 Dec · +$824,000 at $412,000 a day.”

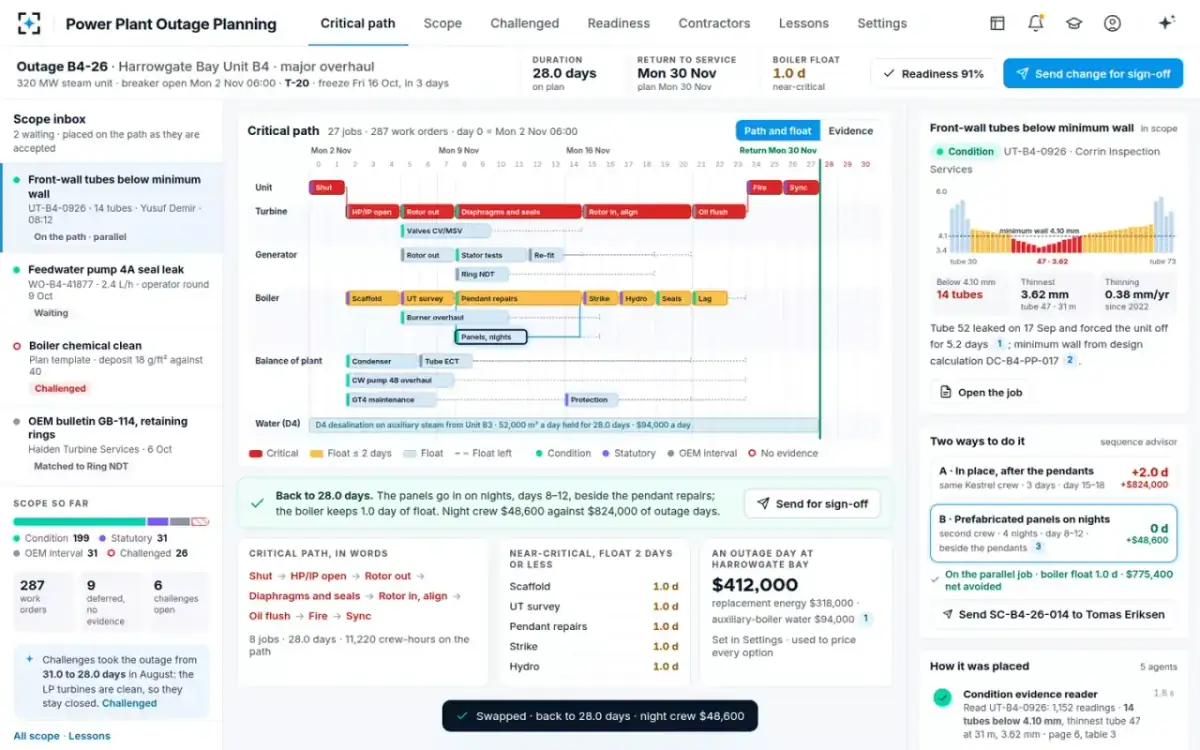

  6. 06The swap

    Panels welded on nights, beside the pendants

    Sequence advisor

    The advisor offers a parallel way, citing lesson L-B3-25-07: sister unit B3 replaced 9 front-wall tubes on nights in 2025 and saved 1.5 days. Kestrel Fabrication prefabricates 2-tube panels before the outage, and a second crew fits them through 7 window cuts on nights, days 8–12. Mariam swaps: back to 28.0 days, boiler float 1.0 day, $775,400 net avoided.

    “Back to 28.0 days. The panels go in on nights, days 8–12, beside the pendant repairs; the boiler keeps 1.0 day of float. Night crew $48,600 against $824,000 of outage days.”

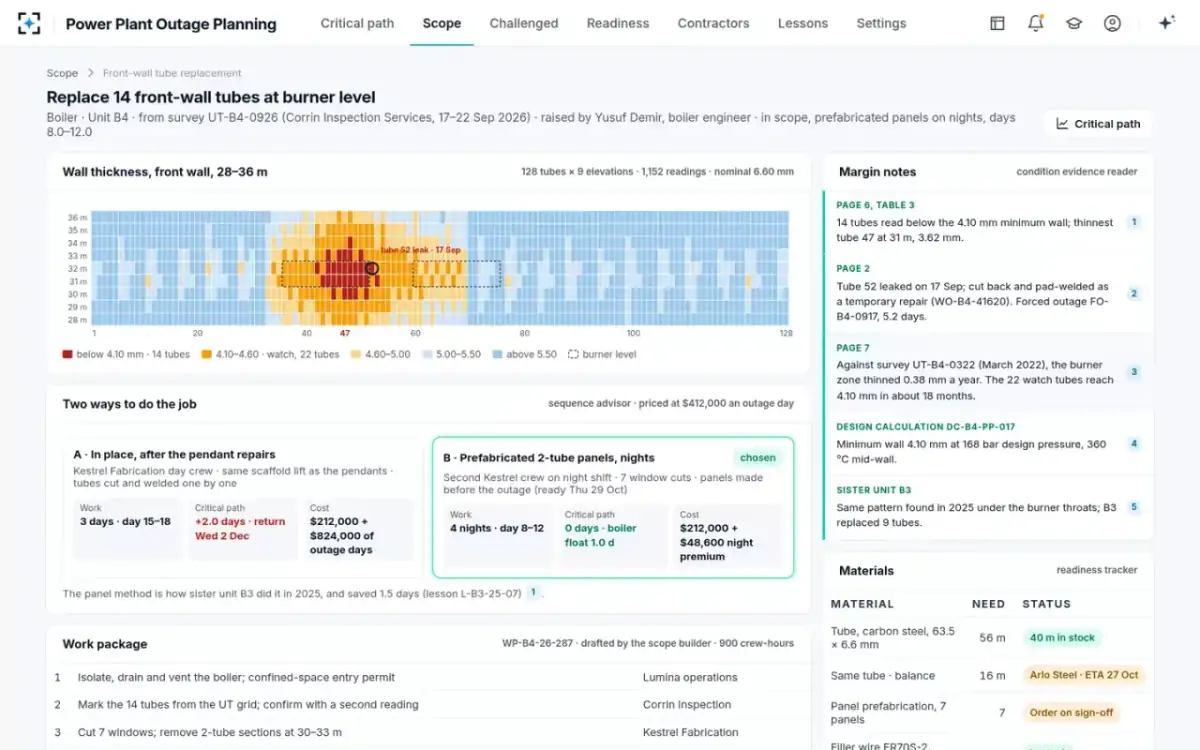

  7. 07The job

    The wall-thickness map behind the job

    Yusuf Demir · Boiler engineer

    The job page shows the front wall as a map of 128 tubes by 9 elevations, coloured by wall: 14 below 4.10 mm, 22 on the 4.10–4.60 mm watch list. Margin notes cite the survey page and table, the forced outage and design calculation DC-B4-PP-017. The work package runs from isolation and confined-space entry through 100 % radiography of the 28 welds and a re-survey of the 22 watch tubes, with each material's quantity and status.

    Margin note: “Against survey UT-B4-0322 (March 2022), the burner zone thinned 0.38 mm a year. The 22 watch tubes reach 4.10 mm in about 18 months.”

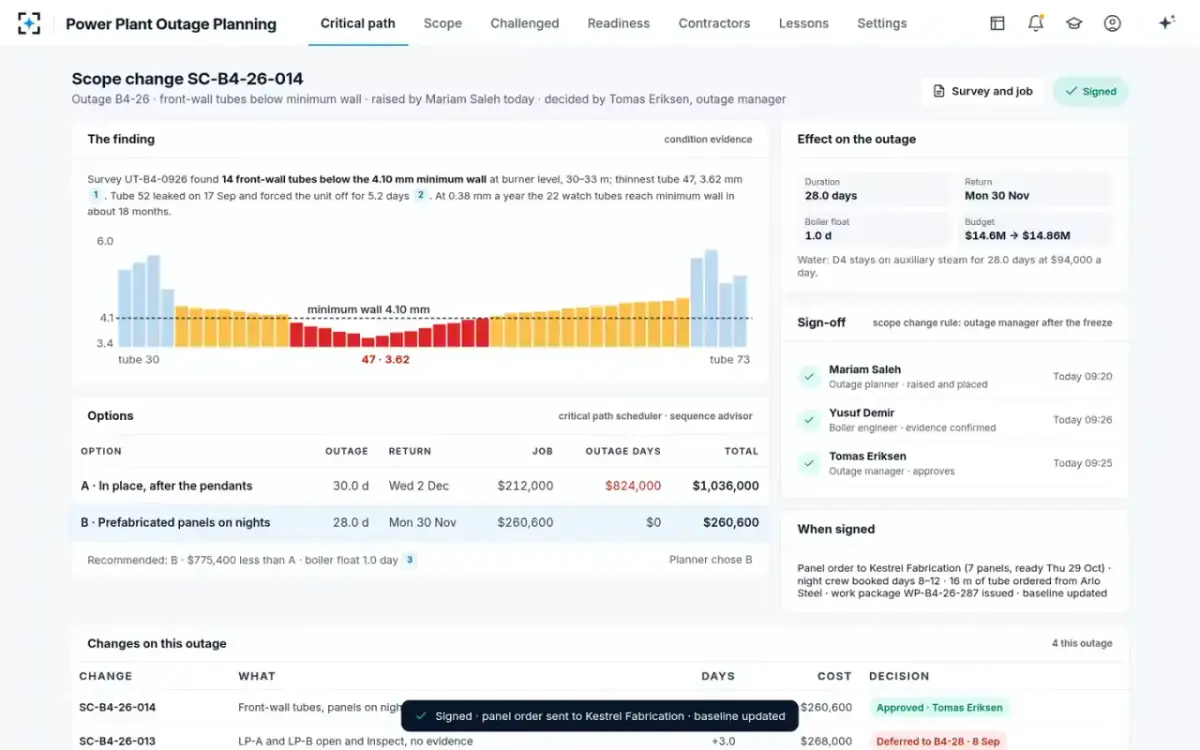

  8. 08Signed

    The evidence, both options and the money on one page

    Tomas Eriksen · Outage manager

    Scope change SC-B4-26-014 goes to Tomas with the finding, the options and their effect. Option A, in place after the pendants: 30.0 days, $1,036,000 with the outage days. Option B, panels on nights: 28.0 days, $260,600. Mariam raised and placed it, Yusuf confirmed the evidence, and Tomas signs as outage manager. The panel order goes to Kestrel and the baseline is updated.

    When signed: panel order to Kestrel Fabrication (7 panels, ready Thu 29 Oct) · night crew booked days 8–12 · work package WP-B4-26-287 issued · baseline updated.

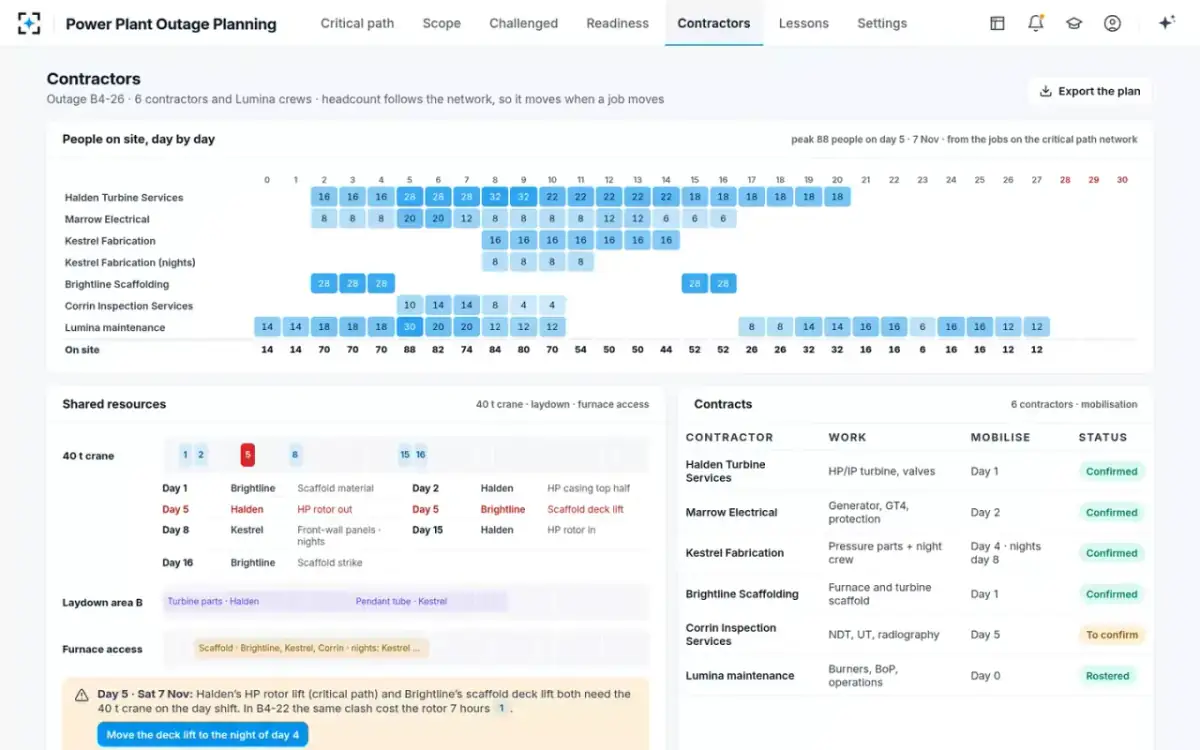

  9. 09Day 5 clash

    One 40 t crane, two lifts on the same shift

    Grace Mwangi · Contracts and procurement

    Headcount follows the network: 88 people on site at the peak, day 5. On that day Halden Turbine Services' HP rotor lift, on the critical path, and Brightline Scaffolding's scaffold deck lift both need the 40 t crane on the day shift. In B4-22 the same clash cost the rotor 7 hours. The fix is one button: move the deck lift to the night of day 4.

    Readiness tracker: it finds the clash and never books a contractor — Grace moves the lift.

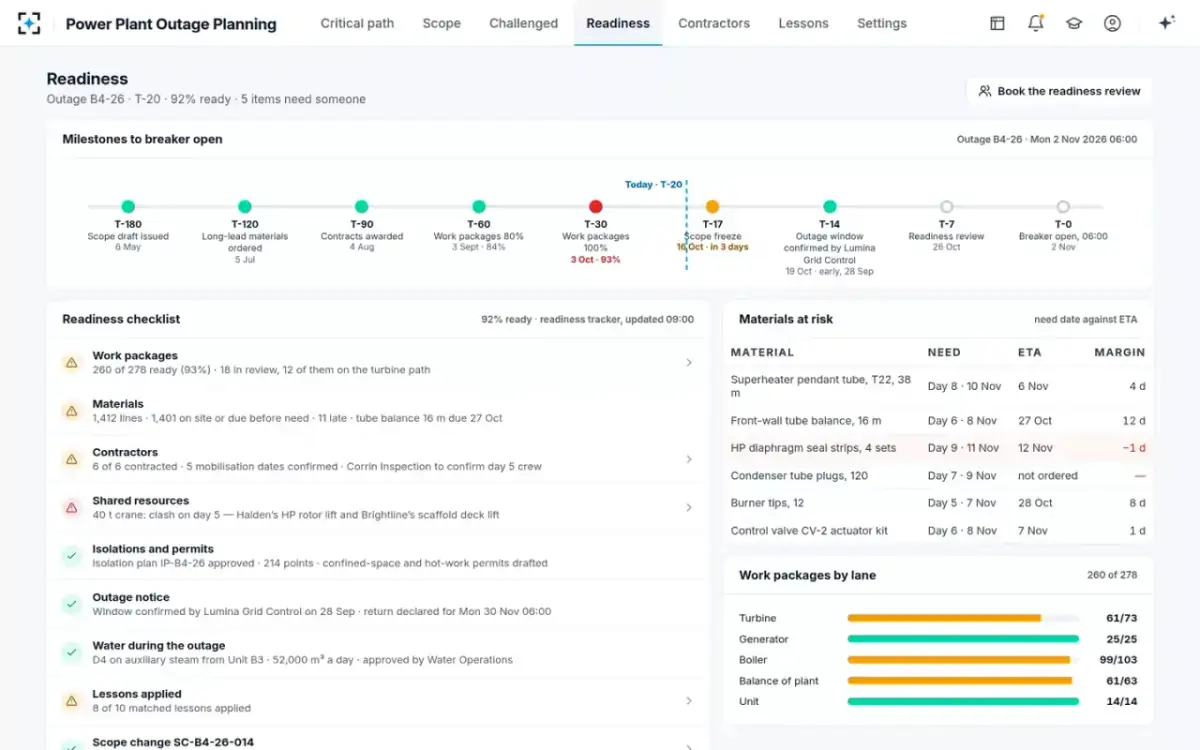

  10. 10T-20 · ready?

    What still needs someone before breaker open

    Readiness tracker

    The milestone line runs from T-180 to breaker open, with the work-package milestone at T-30 missed at 93 %. The checklist covers work packages, materials, contractors, the crane, isolations and permits, the outage notice and the water plan for D4. Materials at risk are listed by need date against ETA: the HP diaphragm seal strips arrive a day after they are needed, and the condenser tube plugs are not yet ordered.

    “D4 on auxiliary steam from Unit B3 · 52,000 m³ a day · approved by Water Operations”

Who it’s for

Built for everyone who carries an outage.

The same outage, seen by the five people who own it — what the weeks before breaker open looked like, and what they look like now.

MS
Mariam SalehOutage planner, Harrowgate Bay Station · places the work and chooses how
Outage planner
Before
Owns the scope and the network for B4-26. “I find out what a finding costs when the schedule is already late.”
Now
Adds a finding and sees the critical path, the return date and the cost redraw at once — with a parallel way to do the job when it would push the date out.
TE
Tomas EriksenOutage manager · chairs the scope change board, signs every change after the freeze
Outage manager
Before
Signs scope changes argued in meetings and spreadsheets. “Show me the evidence and the days, and I'll sign.”
Now
Gets the finding, the options in days and dollars, the effect on the return date and budget, and who confirmed the evidence, on one page.
YD
Yusuf DemirBoiler engineer, Unit B4 · raises findings and confirms the evidence
Boiler engineer
Before
Reads the wall-thickness surveys and raised the front-wall finding. “Fourteen tubes are under minimum wall. They are in, whatever it costs.”
Now
Sees his survey read, mapped tube by tube and cited by page and table in the job, and confirms the evidence before the change is signed.
DK
Daniel KovačTurbine engineer · owns the turbine path, the longest in the outage
Turbine engineer
Before
Argues each outage against time-based items. “The LP turbines are clean. Opening them is six years of habit.”
Now
Sees every item with no reading challenged — the LP turbine opening deferred to B4-28 with its reason, 3.0 days off the outage.
GM
Grace MwangiContracts and procurement · contractor mobilisation, materials and the shared crane
Contracts and procurement
Before
Chases materials and crane bookings for six contractors. “Tell me the need date, not ‘as soon as possible’.”
Now
Sees each material's need date against its ETA, headcount by day from the network, and the crane clash with its fix — she places the orders.
Built on the engine

7 agents. Each with one job, and hard limits.

Seven agents read the evidence, build the scope and place every job on the critical path; the planner chooses and the outage manager signs.

Condition evidence reader

Reads inspection reports, wall-thickness surveys, vibration, oil and thermography trends and OEM bulletins; extracts every reading with its location, unit and limit, computes the rate against the previous survey, and links it to the scope item it justifies.

  • Never invents or estimates a reading
  • Every value cites its page and table
  • Marks a reading older than 36 months as stale
Scope builder

Turns findings, deferred work orders and OEM bulletins into scope items: job steps, materials with quantities, crew-hours by trade, permits and the contractor, joining any open work order on the same equipment.

  • Never adds to the approved baseline on its own
Evidence challenger

Looks for a reading, test, bulletin or statutory rule behind every scope item; challenges any with none, saying where it came from, what it looked for and what it found, and proposes defer, split or keep with the days and hours it carries.

  • Never challenges a statutory item
  • Never removes an item — a person decides
Critical path scheduler

Places each job on the outage network with its logic, crew and shared resources, runs the forward and backward pass, and reports the change to the end date, the critical path and the float, priced at the value of an outage day.

  • Never changes the approved baseline without a signed scope change
Sequence advisor

When a job lengthens the critical path, looks for ways to take it off — a second crew or shift, prefabrication, different access, a different window — prices each in days and dollars, and cites the lesson that supports it.

  • Recommends one option; never picks it — the planner does
Readiness tracker

Watches materials against need dates, contractor mobilisation, permits, shared-resource clashes such as the 40 t crane, and the milestones to breaker open.

  • Never places an order or books a contractor

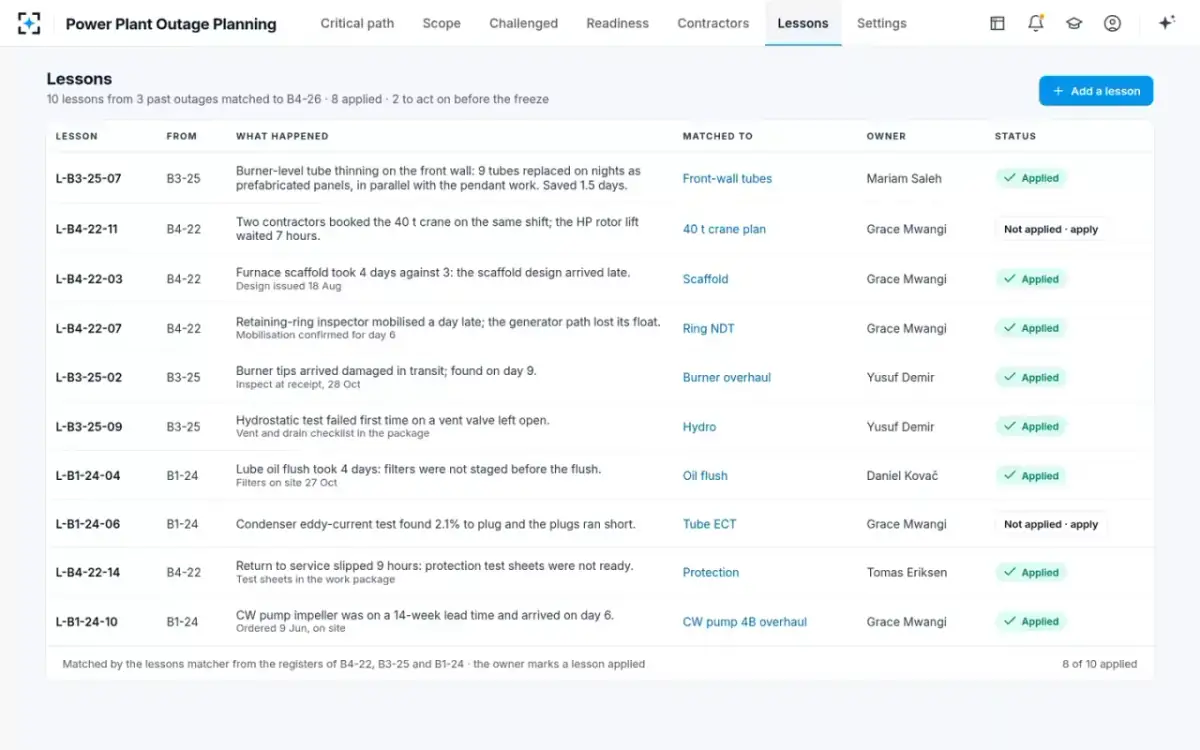

Lessons matcher

Matches lessons from past outages on this and sister units — the registers of B4-22, B3-25 and B1-24 — to the current scope items.

  • Never marks a lesson applied — the owner does
Outage manager

Signs every change after the freeze. The agents propose; a named person decides.

Ask in plain words

Ask about any job, finding or date on the outage

Ask about any job, finding, contractor or date on outage B4-26 — or say what to change. Every answer points to its records.

Why is the front-wall tube job in the scope?

Because the survey says so. UT-B4-0926 found 14 front-wall tubes below the 4.10 mm minimum wall at burner level; the thinnest, tube 47, reads 3.62 mm. Tube 52 already leaked on 17 Sep and forced the unit off for 5.2 days. The minimum wall comes from design calculation DC-B4-PP-017. It is condition evidence, so it will not be challenged.

What does the tube job do to the critical path?

Done in place after the pendant repairs, it puts the boiler on the critical path: +2.0 days, return Wed 2 Dec, about $824,000 at $412,000 a day. Done as prefabricated panels on nights beside the pendants, it costs 0 days and $48,600 — how B3 did it in 2025.

Which scope items have no evidence?

26 of 286 work orders had no reading, test or bulletin behind them. 9 are deferred to B4-28 (1,940 crew-hours, $462,000), 11 were kept once evidence was found, and 6 are open — among them the boiler chemical clean (18 g/ft² against 40, 2.5 days on the path). The LP turbines were the big one: deferring them took the outage from 31.0 to 28.0 days.

Are we ready for breaker open on 2 November?

91 % ready at T-20. Three things need someone this week: work packages are at 93 % against the 100 % milestone missed on 3 Oct; the 40 t crane is double-booked on day 5; and the HP diaphragm seal strips arrive a day after they are needed. Isolations, the outage notice and the water plan for D4 are done.

Every screen

The working solution, as it ships.

13 screens from the working solution, on its sample data. Pick one to see it large.

The critical pathOutage B4-26 as a time-scaled network: the red critical path, float on every lane, the return date and the value of an outage day, with the scope inbox and the new finding beside it.
Why each job is in the outageThe same network coloured by evidence — condition, statutory, OEM interval, or no evidence and challenged.
Agents placing the jobThe survey read and cited, the job drafted with its crew-hours and materials, and the stock and ETAs checked, step by step.
The path grows two daysPlaced after the pendant repairs, the tube job makes the boiler path critical: 30.0 days, return Wed 2 Dec, +$824,000 — with two ways to do it.
Swapped for the parallel jobPrefabricated panels on nights beside the pendants: back to 28.0 days, boiler float 1.0 day, for a $48,600 night crew.

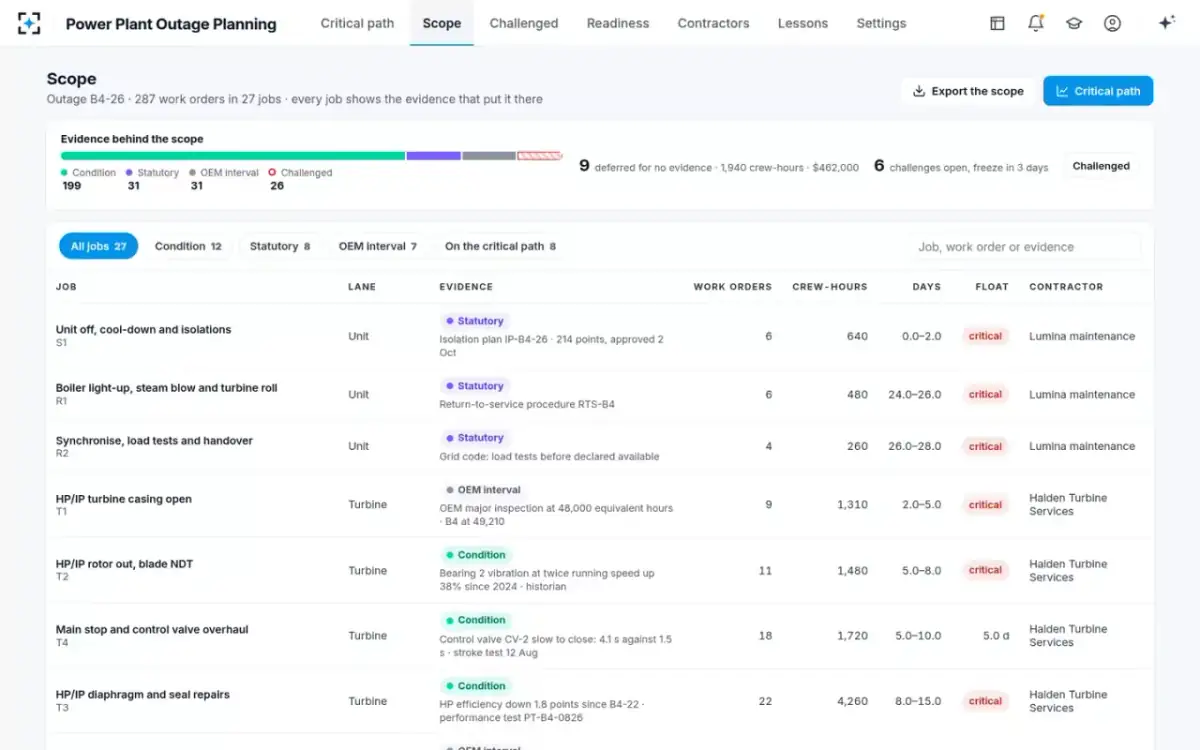

The scope itemThe wall-thickness map of the front wall, margin notes citing each source, both options and the work package.
The scopeEvery job with its evidence, work orders, crew-hours, days, float and contractor, filtered by evidence type or the critical path.
ChallengedItems with no current evidence — where each came from, what was looked for and found, and the proposal to defer, split or keep.
The signed scope changeThe finding, the options in days and dollars, the effect on the outage and budget, the sign-off and what happens when it is signed.
Contractors and the cranePeople on site day by day from the network, the 40 t crane, laydown and furnace access, and the day-5 clash with its fix.
ReadinessMilestones from T-180 to breaker open, the readiness checklist, materials at risk by need date against ETA, and work packages by lane.
LessonsLessons from B4-22, B3-25 and B1-24 matched to this outage's jobs, each with its owner and whether it was applied.
Your rulesThe outage window and freeze, the value of an outage day, what counts as evidence, the challenge rules and who signs.
Governance

Evidenced, challenged, signed — on the record.

Every job cites its evidenceEach scope item shows the reading, test, bulletin or statutory rule that put it in the outage — the survey, its page and table, the trend in the historian, the OEM bulletin.
No evidence is challenged; statutory work never isItems carried over from a template, time-based only or proposed by a contractor are challenged with what was looked for and found. A person keeps, splits or defers each one; the agents never remove an item.
After the freeze, the outage manager signsEvery scope change after the freeze goes to the outage manager with the evidence, the options and their days and dollars, the effect on the return date and the budget, and the plant engineer's confirmation.
The baseline changes only on a signatureThe critical path scheduler shows the effect of every option but never changes the approved baseline without a signed scope change.
Agents never order or bookThe readiness tracker watches materials, crews and the crane; contracts and procurement place the orders and book the contractors. The sequence advisor recommends; the planner chooses.
Every step on the activity trailEach agent step and each decision — who raised a finding, who confirmed the evidence, who signed — is recorded with its time, and every change to the rules is kept as a new rule version with its reason.

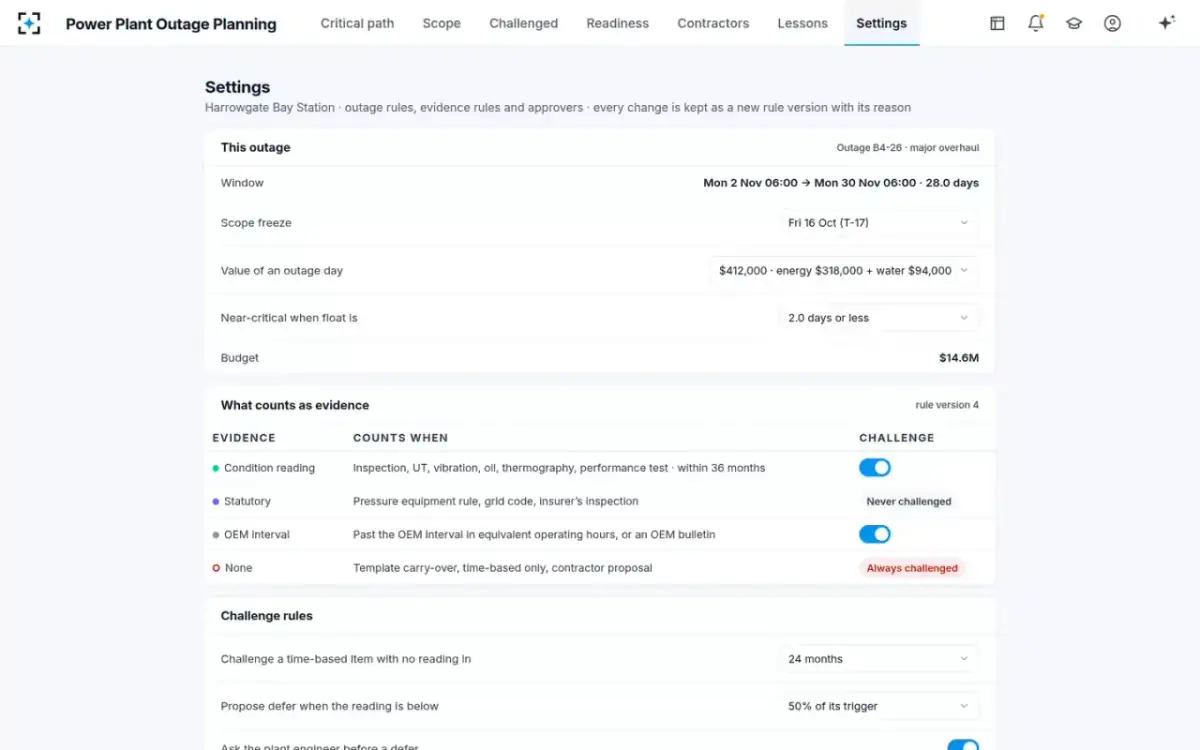

Configuration

Your station's outage rules, not ours

The freeze, the value of an outage day, what counts as evidence and who signs are settings, chosen by the station.

SettingDefaultChoose from
Scope freezeFri 16 Oct (T-17)Fri 16 Oct (T-17) · Mon 19 Oct (T-14) · Fri 9 Oct (T-24)
Value of an outage day$412,000 (energy $318,000 + water $94,000)$412,000 · $380,000 at the winter energy price — used to price every option
Near-critical when float is2.0 days or less2.0 days or less · 1.0 day or less · 3.0 days or less
Condition reading counts whenWithin 36 monthsInspection, UT, vibration, oil, thermography, performance test — statutory items are never challenged; items with no evidence always are
Challenge a time-based item with no reading in24 months24 months · 12 months · 36 months
Propose defer when the reading is below50 % of its trigger50 % · 30 % · 70 % of its trigger
Ask the plant engineer before a deferOnOn · Off
Connections

Works with the records an outage is already planned from

Work ordersopen, deferred and planned, from the maintenance system, synced every hour
Inspection and test reportswall-thickness surveys, replica reports, thermography and test results, as PDF and spreadsheets
Plant datathe historian — vibration, temperatures, performance
OEM bulletinsturbine, generator and boiler makers' recommendations and intervals
Lessons registerswhat happened in past outages on this and sister units, and what was done about it
Spares and contractorspurchase orders, contractor plans and the shared-resource calendar
What it changes

The difference, in numbers.

Every figure is labelled: a target the solution is built to, an estimate, a typical published result, or a proven one.

estimated
$412ka day
for every outage day avoided at a 320 MW steam unit that also makes water — one finding re-sequenced kept two
Placed in sequence30.0 days · +$824,000
Swapped to a parallel job28.0 days · +$48,600
target
92%
scope stability target — little work added after the freeze, because findings are scoped from condition data first
top-quartile benchmark
demo
26of 26
items with no evidence challenged before they cost crew-hours; 9 deferred, 1,940 crew-hours and $462,000
26 of 26 challenged
9 deferred with their reason

“demo” = seen in the working solution, on its sample outage data · “target” = the design goal, measured in the live solution · “estimated” = our estimate · “typical” = published figures (a Portland General Electric regulatory filing on a coal unit outage, 2006 — $450,000–700,000 a day of replacement power; INPO AP-928 benchmarks cited in an Ontario Energy Board filing — 92 % top-quartile scope stability). The $412,000 value of an outage day is the demo utility's own setting (energy $318,000 + water $94,000). Lumina Utilities, Harrowgate Bay Station, its contractors, people and records named on this page are fictional — characters and sample data in the working solution.

Questions

What outage teams ask us.

What is power plant outage planning software?

Software that builds and controls the scope and schedule of a planned unit outage — what work goes in, why, when it is done and what it does to the return-to-service date. Power Plant Outage Planning adds seven agents that build the scope from condition data, challenge work with no evidence and place each job on the critical path; the planner chooses and the outage manager signs.

How does outage scope management work in the solution?

Every scope item carries the evidence that justifies it: a condition reading within 36 months, a statutory rule, an OEM interval or bulletin. Items with none — a template carry-over, time-based only, a contractor proposal — are challenged with what was looked for and found, and a person keeps, splits or defers them. In the sample outage, 9 of 26 challenged items were deferred, taking 3.0 days out.

How does it show what a new finding does to the critical path?

When the planner adds a finding, the scope builder drafts the job and the critical path scheduler places it on the network with its crew and shared resources, then recomputes the path and float. The header shows the new duration, return date and cost at once — in the sample case +2.0 days, return Wed 2 Dec, +$824,000.

What happens when a finding would push out the return date?

The sequence advisor looks for a parallel way — a second crew or shift, prefabrication, different access or a different window — prices each in days and dollars and cites the past lesson behind it. It recommends one; the planner chooses. In the sample case prefabricated panels on nights held the outage at 28.0 days for $48,600.

Does it count the cost of lost water at a plant that also makes water?

Yes, if you set it. The value of an outage day is a setting used to price every option; at Harrowgate Bay it is $412,000 — replacement energy $318,000 plus $94,000 for water from the auxiliary boiler while desalination unit D4 runs on steam from another unit.

How does it keep the outage ready for breaker open?

The readiness tracker watches milestones from T-180 to breaker open, work packages, materials by need date against ETA, contractor mobilisation, permits and clashes on shared resources such as the 40 t crane. The lessons matcher puts lessons from past outages against this outage's jobs. Neither places an order, books a contractor or marks a lesson applied.

Do people stay in control of the scope and the baseline?

Yes. The agents read, draft, challenge and propose; they never remove an item, pick an option, order material or change the approved baseline. The planner places work and chooses how, the plant engineer confirms the evidence, and every change after the freeze is signed by the outage manager.

How long does it take to go live?

The Agentic Solution Engine builds and deploys it from your requirements and documents — your outage procedures, evidence and challenge rules, scope templates, inspection reports and lessons registers — and it goes live once every quality gate has passed. We will walk you through it on one of your own past outages first.

See it on
your next outage.

We'll run Power Plant Outage Planning on the scope, surveys and lessons of one of your past outages.
